| Name | Hoy Bridge Chicago, Milwaukee, St. Paul & Pacific Railroad Bridge #Z-1040 |
| Built By | Chicago, Milwaukee & St. Paul Railway |
| Currently Owned By | Marshall County Conservation Board |
| Builder | Chicago, Milwaukee & St. Paul Railway Company Forces |
| Engineers | J.H. Prior (Engineer of Design) Charles Frederick Loweth (Chief Engineer) |
| Length | 212 Feet Total, 60 Foot Spans |
| Width | 2 Tracks |
| Height Above Ground | 56 Feet |
| Superstructure Design | Open Spandrel Concrete Arch and Closed Spandrel Concrete Arch |
| Substructure Design | Concrete |
| Date Built | 1912 |
| Traffic Count | 0 Trains/Day (Bridge is Open to Pedestrian Traffic) |

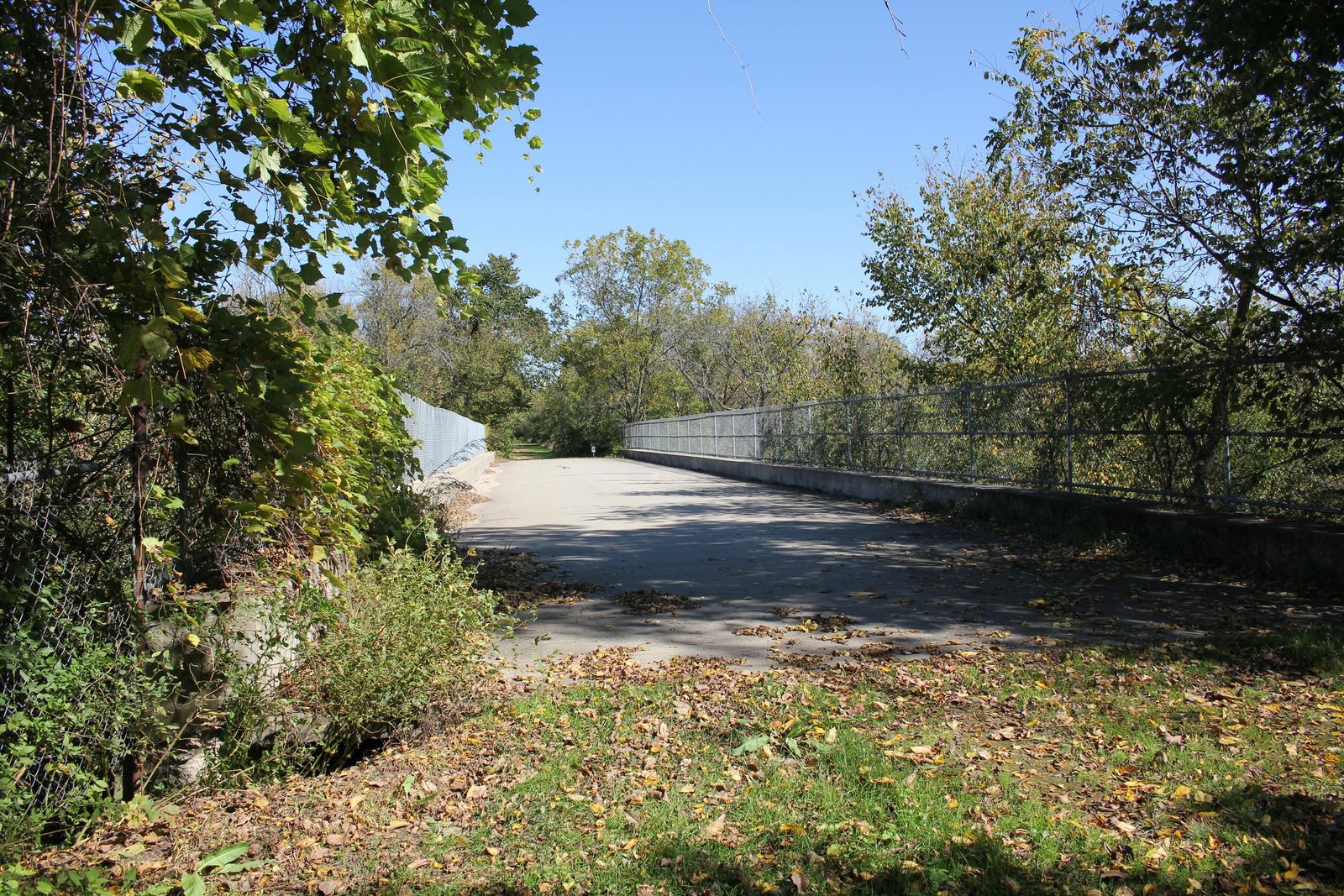

| Current Status | Open to Pedestrian Traffic |
| Chicago, Milwaukee, St. Paul & Pacific Railroad Bridge Number | Z-1040 |
| Significance | High Significance |
| Documentation Date | 8/11/2013; 10/7/2016 |
In 1870, the Sabula, Ackley & Dakota Rail Road (SA&D) constructed a 21-mile railroad line, extending from the Mississippi River at Sabula, Iowa to Preston, Iowa. The following year, an additional 12 miles were completed to Delmar, Iowa. In 1872, an additional 54 miles were completed to Marion, Iowa. In 1872, the SA&D was conveyed to the Milwaukee & St. Paul Railway (M&StP), which reorganized as the Chicago, Milwaukee & St. Paul Railway (Milwaukee Road) in 1874. In 1882, the Milwaukee Road completed an additional 257 miles between Marion and Council Bluffs, Iowa; completing a mainline from the Mississippi River to the Missouri River. The same year, a bridge across the Mississippi River was completed at Sabula, which connected to the existing Milwaukee Road system in Illinois. By the late 19th Century, the Milwaukee Road had developed a large railroad network throughout the Midwest. This line quickly became a principal mainline for the Milwaukee Road, and allowed for the connection and construction of other branch lines throughout Iowa.
In 1901, a short 12-mile cutoff was completed between Green Island, Iowa and Browns Junction, Iowa; which shortened the distance and provided better grades. The original line was retained as a second track. In the early 20th Century, the Milwaukee Road was aware of the importance of this line, and a massive construction project was planned to modernize the line. Between 1912 and 1915, the line between Green Island and Manilla, Iowa was extensively rebuilt, with a second track constructed and large sections of line relocated. The result was one of the most modern double track lines in Iowa, complete with smooth curves, gentle grades and new bridges. After completion of the project, some short sections of the original line were retained as spurs, which were abandoned by the early 1920s. The Milwaukee Road failed to accurately project the level of traffic over this line, and traffic never reached the threshold that required a double track line. The Milwaukee Road was often in financial trouble, especially after the costly Pacific Extension was completed in 1909. In 1925, the company declared bankruptcy, and reorganized as the Chicago, Milwaukee, St. Paul and Pacific Railroad in 1928. Despite the financial strain, this line remained an important mainline for the Milwaukee Road. Segments between Marion and Covington, Iowa; Newhall, Iowa and Collins, Iowa; and Madrid, Iowa and Templeton, Iowa were reduced to a single track in 1934. The segment between Green Island and Paralta, Iowa was reduced to a single track in 1950; the segment between Paralta and Marion in 1954; the segment between Collins and Madrid, Iowa in 1956 and the segment between Covington and Newhall in 1964. In addition, the original line east of Browns Junction was abandoned in 1950. Financial hardship continued through the 20th Century for the Milwaukee Road, and the railroad again filed bankruptcy in 1977. In 1980, the Milwaukee Road decided to abandon the entire Iowa Division mainline. The segment between Bayard, Iowa and Council Bluffs was sold to Burlington Northern Railroad (BN). Segments between Perry, Iowa and Bayard and between Slater, Iowa and Woodward were sold to the Chicago & North Western Railway (C&NW). A short segment at Marion was sold to the Chicago Central & Pacific Railroad (CC).
In 1985, the segment between Herndon and Bayard was abandoned by the C&NW. In 1995, the C&NW was purchased by Union Pacific Railroad (UP). In 1996, BN merged with the Atchison, Topeka & Santa Fe Railway to form BNSF Railway. The CC was purchased by Illinois Central Railroad (IC) in 1996, and the IC was purchased by Canadian National Railway (CN) in 1998. In 1999, the segment between Dawson, Iowa and Herndon was abandoned by UP. In 2002, most of the segment at Marion was abandoned by CN. Between 2003 and 2004, the remaining portions between Slater and Woodward and between Perry and Dawson were abandoned by UP. Today, BNSF operates the Bayard to Council Bluffs segment as the Bayard Subdivision, and CN still operates a short segment of line in Hiawatha. Linn County has developed large sections around Marion into the Grant Wood Trail. A section west of Rhodes, Iowa has been reused as a trail; and segments between Collins and Slater have been reused as the Heart of Iowa Nature Trail. Much of the line between Slater and Perry has been reused as the High Trestle Trail; and the line between Perry and Herndon has been reused as the Raccoon River Valley Trail. Remaining segments have been abandoned, with much of the right-of-way still intact. In addition, large segments of the original right-of-way that was replaced in the early 20th Century remain intact.
View historic articles discussing the double tracking of this line (digitized by Google)

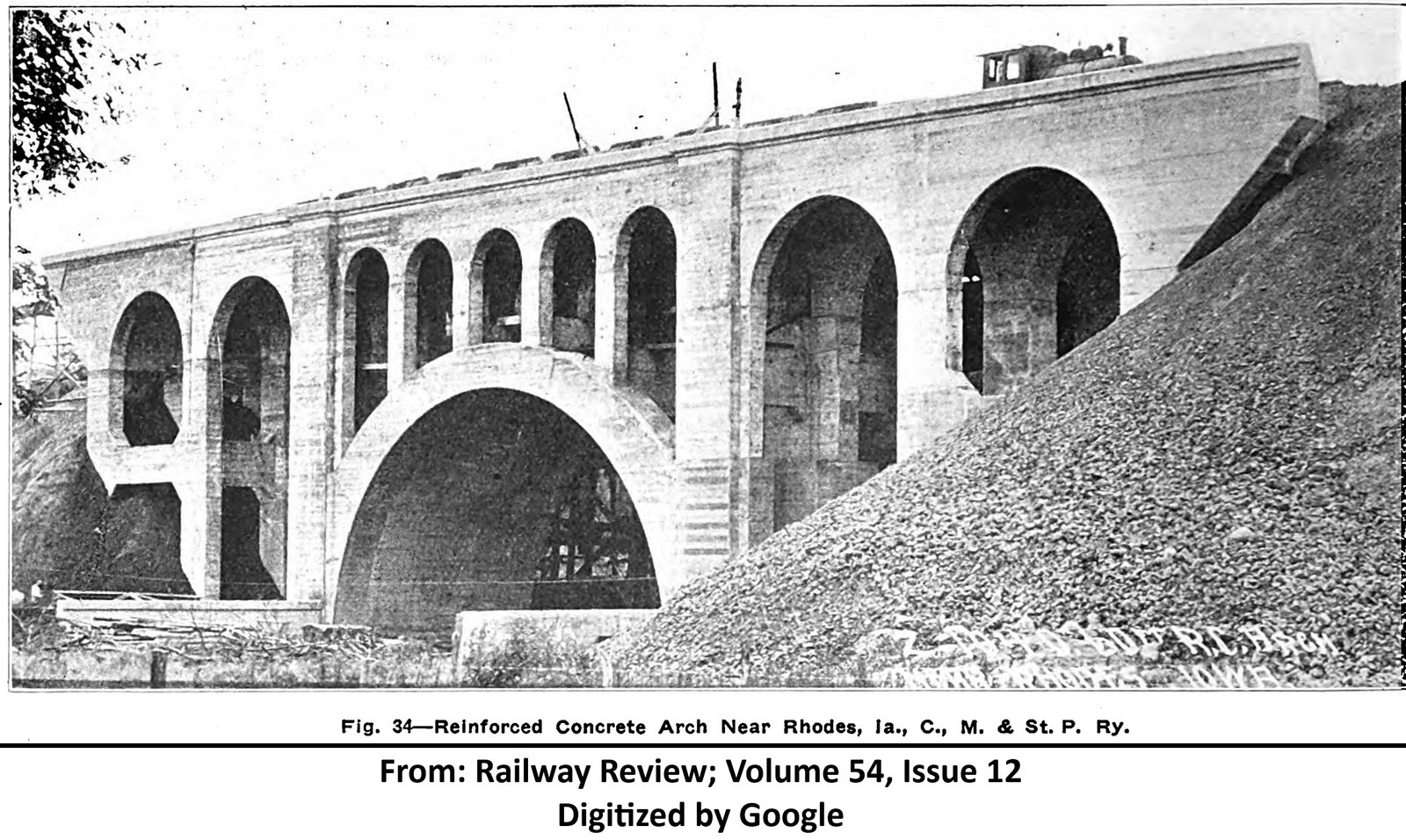

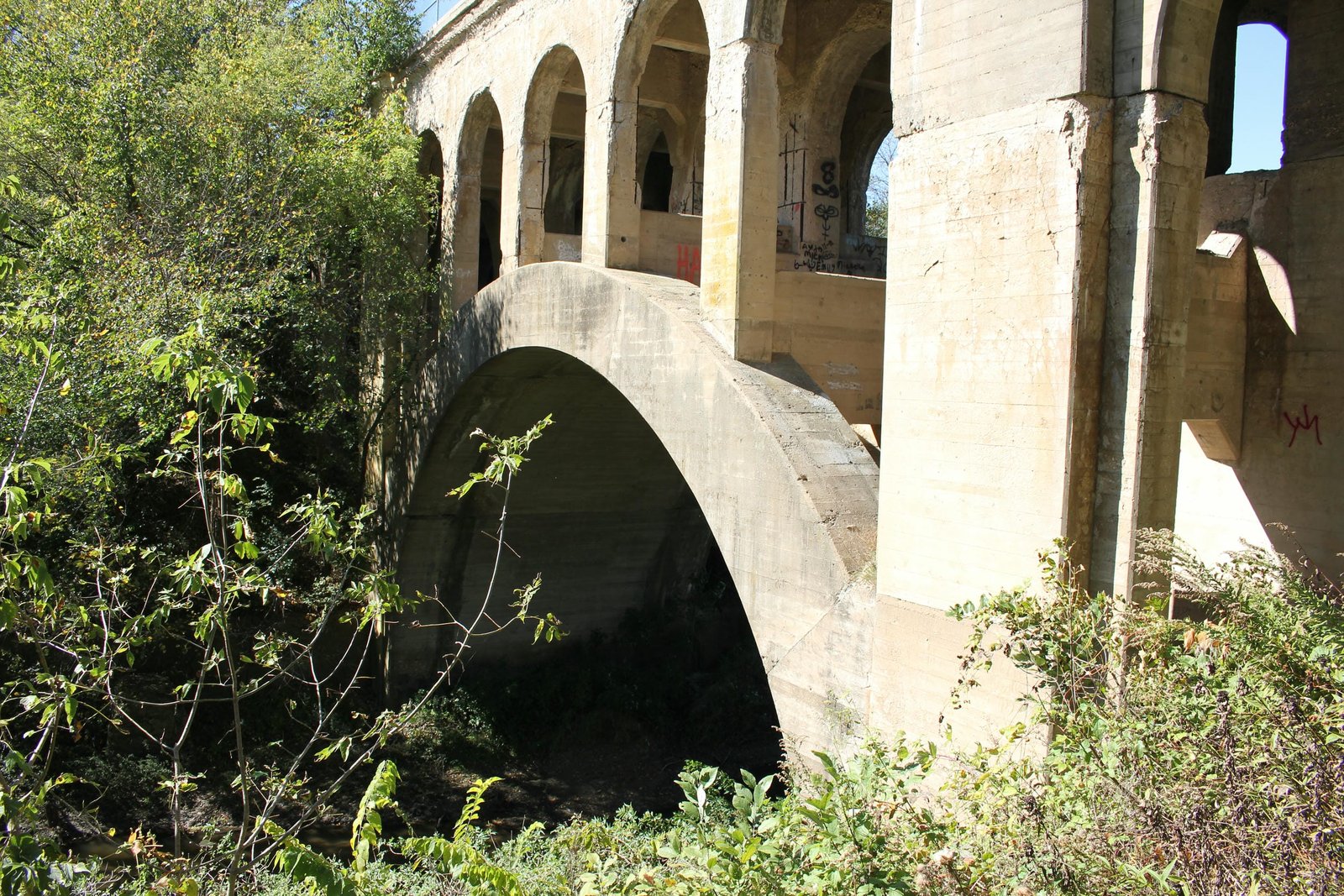

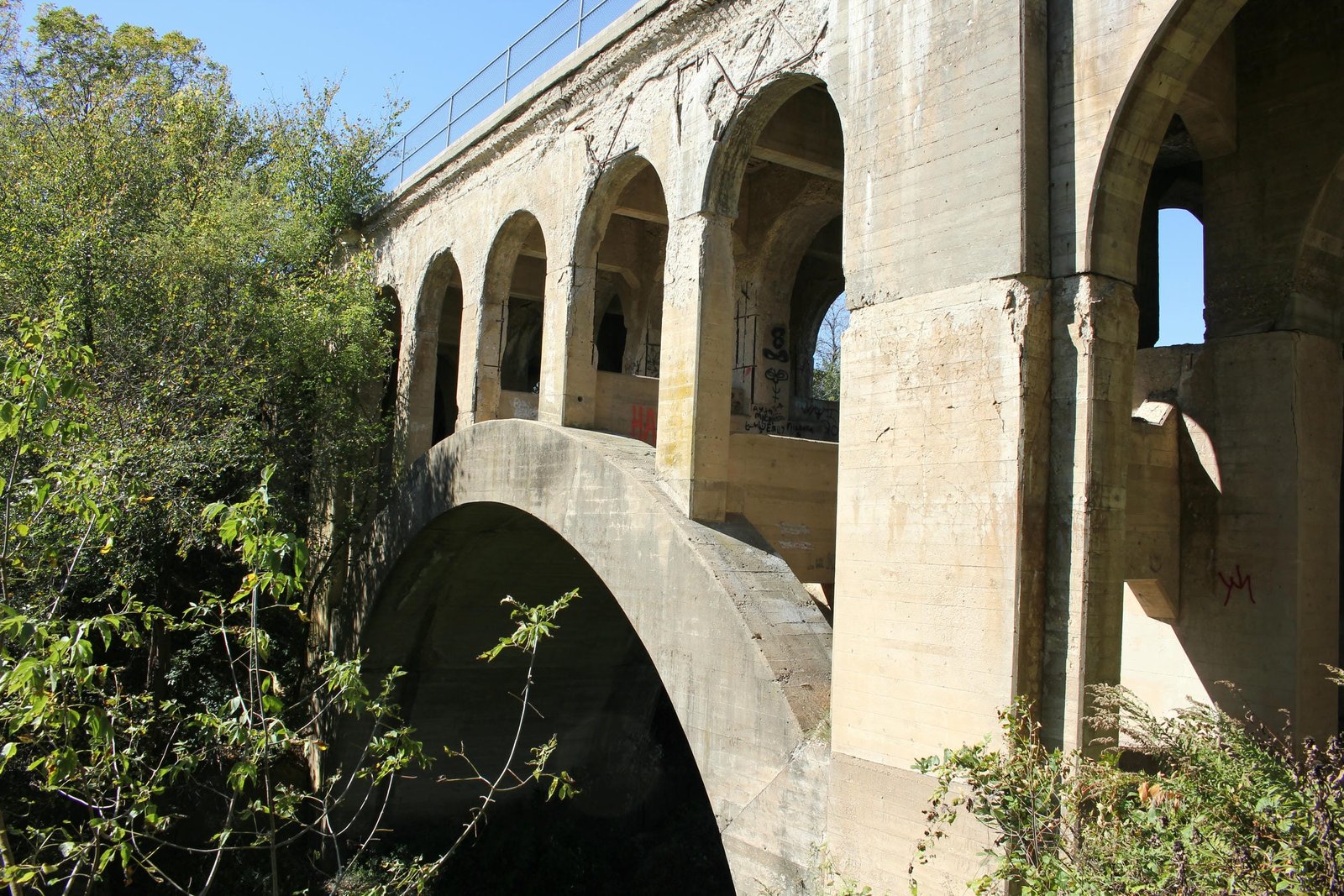

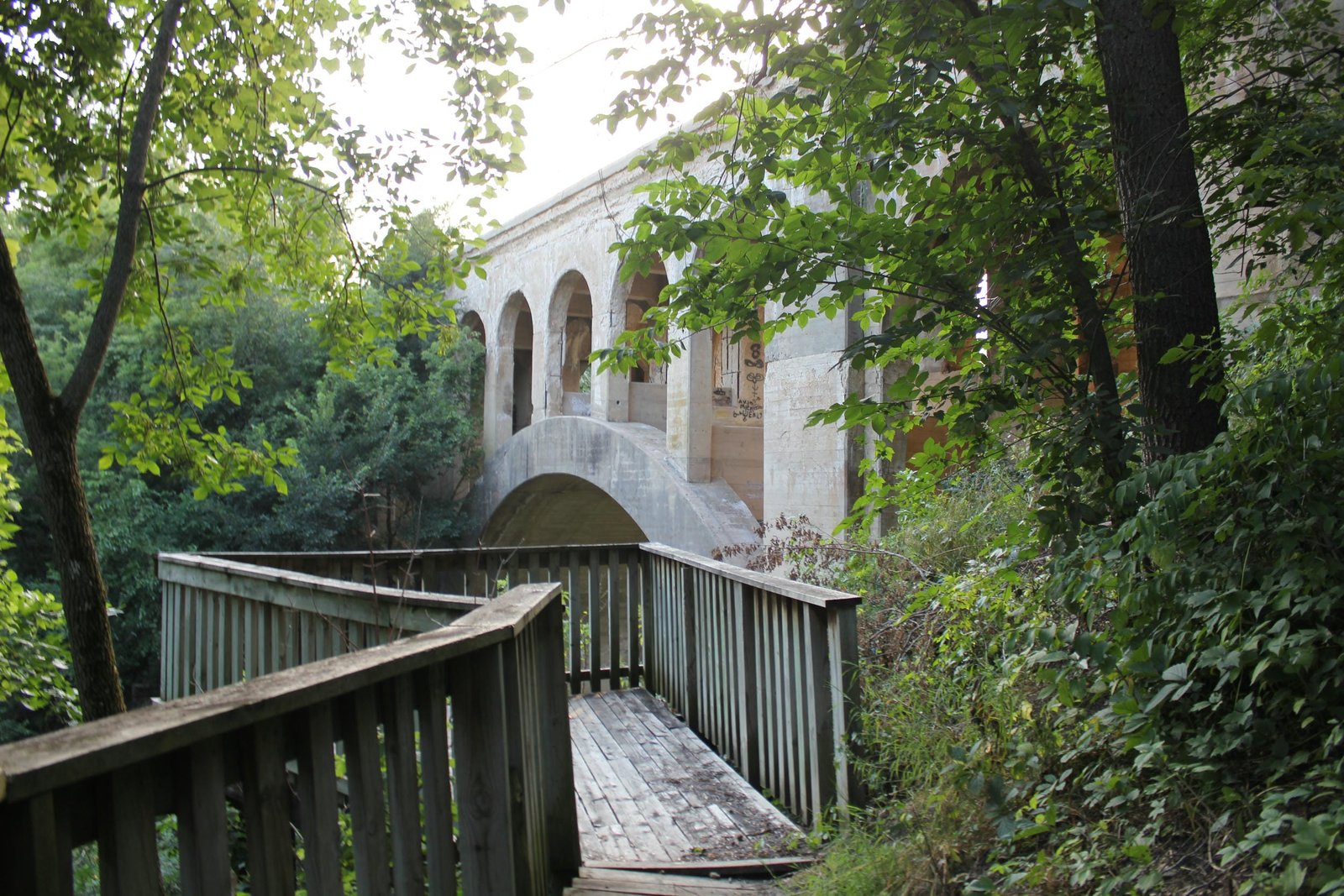

Located west of Rhodes, this massive concrete arch bridge carries a former Chicago, Milwaukee, St. Paul & Pacific Railroad (Milwaukee Road) mainline across Clear Creek. The first bridge at this location likely consisted of a tall and lengthy timber pile trestle bridge, constructed for a single track when the line was first built. During the mid to late 1890s, the Milwaukee Road replaced many of the timber bridges along this line with steel, stone and concrete structures. In 1898, a new steel viaduct was constructed at this location. This bridge consisted of three 63-foot fishbelly deck plate girder spans, two 32-foot deck plate girder tower spans and steel towers. The towers were supported by concrete pedestals, the ends of the bridge were supported by timber bents and the bridge was fabricated by an unknown firm. Between 1912 and 1915, the Milwaukee Road reconstructed the mainline across Iowa, improving the alignment and grades, constructing new bridges and adding a second track. At this location, the line was slightly realigned so that the new bridge would be immediately north of the steel viaduct. Work on the bridge began on April 30th 1912, and the structure was completed on June 19th, 1913. After the new bridge was completed, the old bridge was removed and reused at a number of locations. One of the 63-foot spans was converted to a through plate girder and reused at Bridge #Z-1028, which carried Walnut Street (Iowa Highway 245) in Rhodes. That bridge was replaced in 1977 by a modern concrete bridge. Another 63-foot span was converted to a through plate girder and reused as an overpass at Bridge #Z-1282 1/2 near Dedham, Iowa, which continues to stand today. A third span was reused at Bridge #W-72 near Kennebec, South Dakota; which is still intact today. It is unclear if the two tower spans were reused, or if they still exist today.

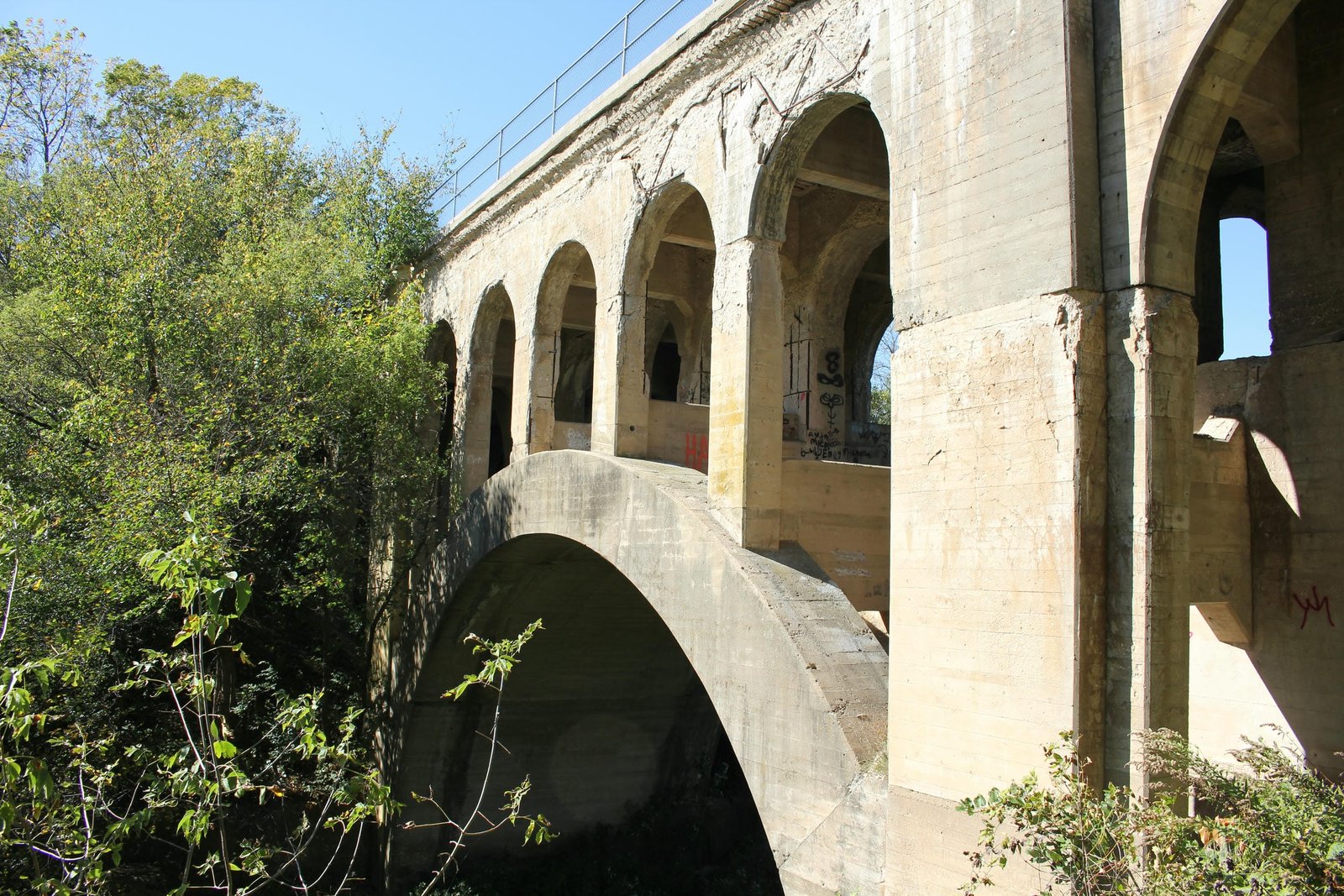

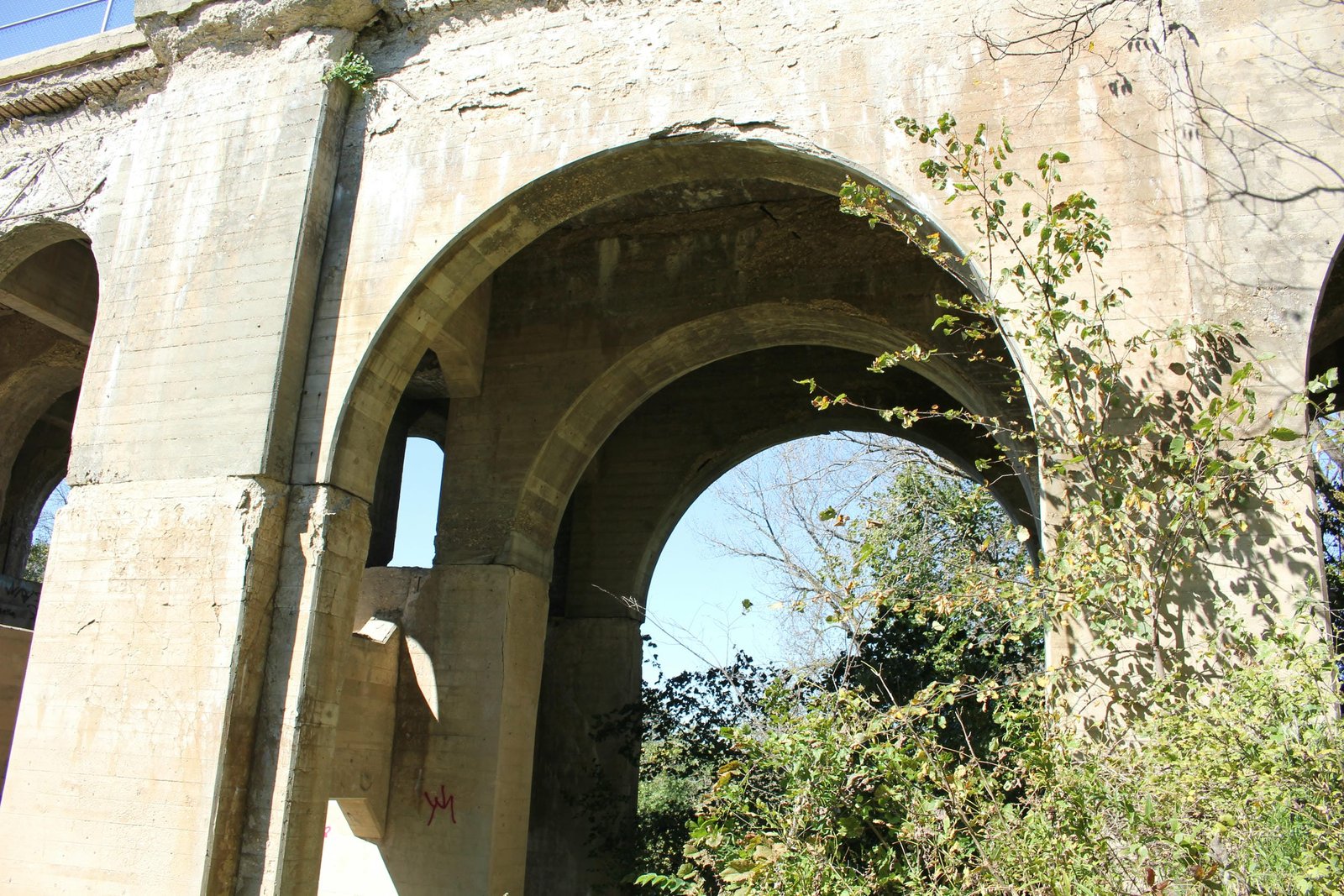

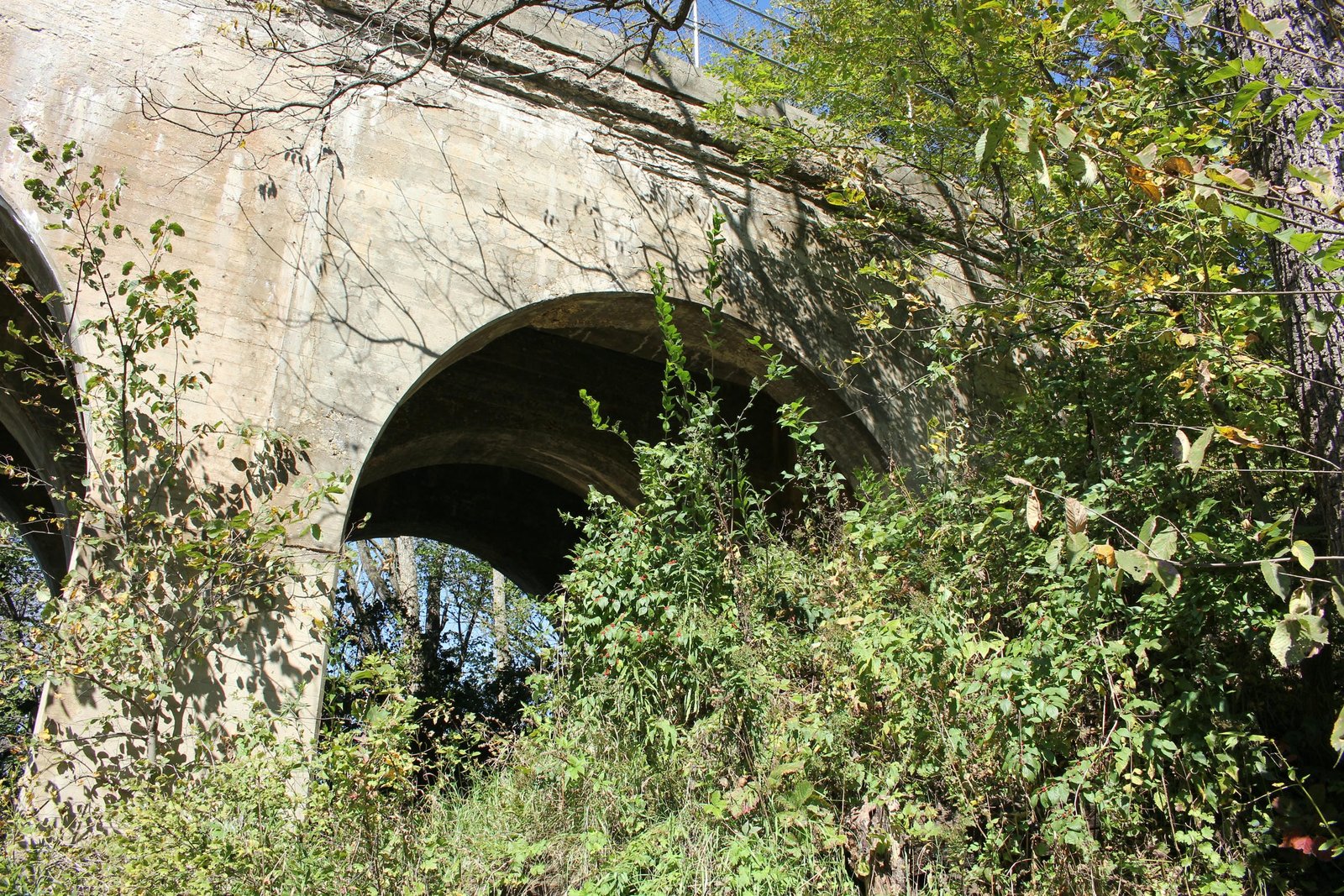

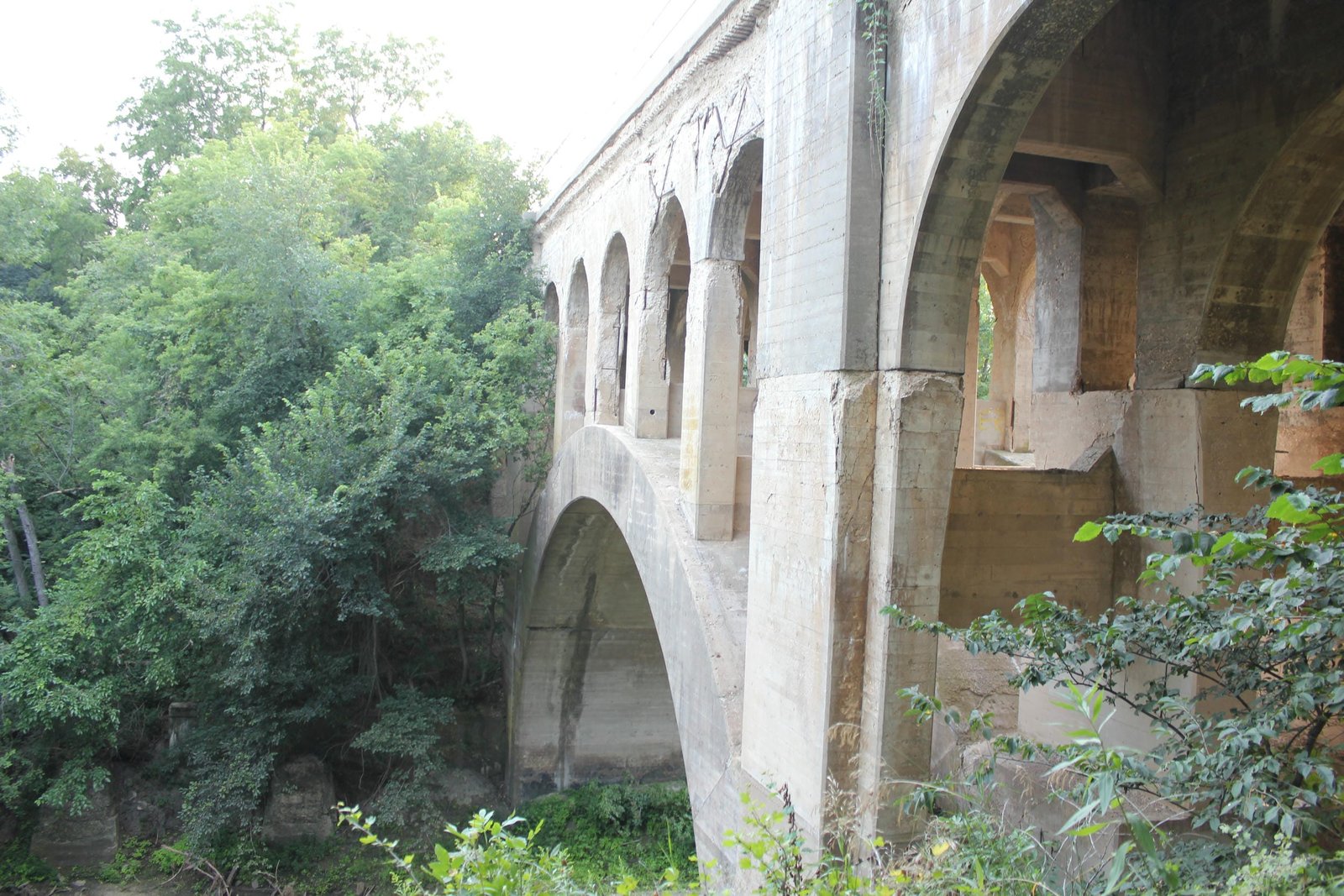

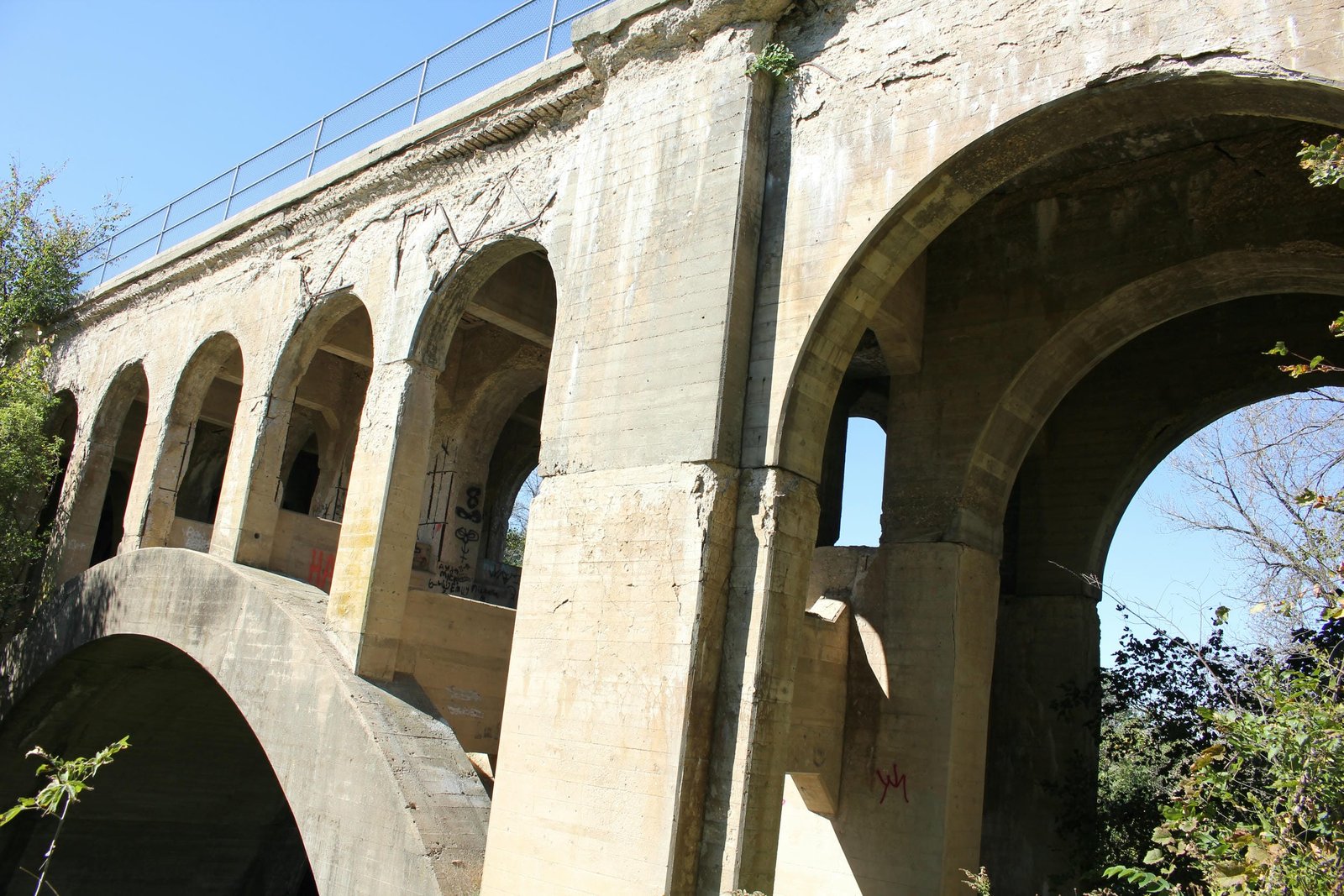

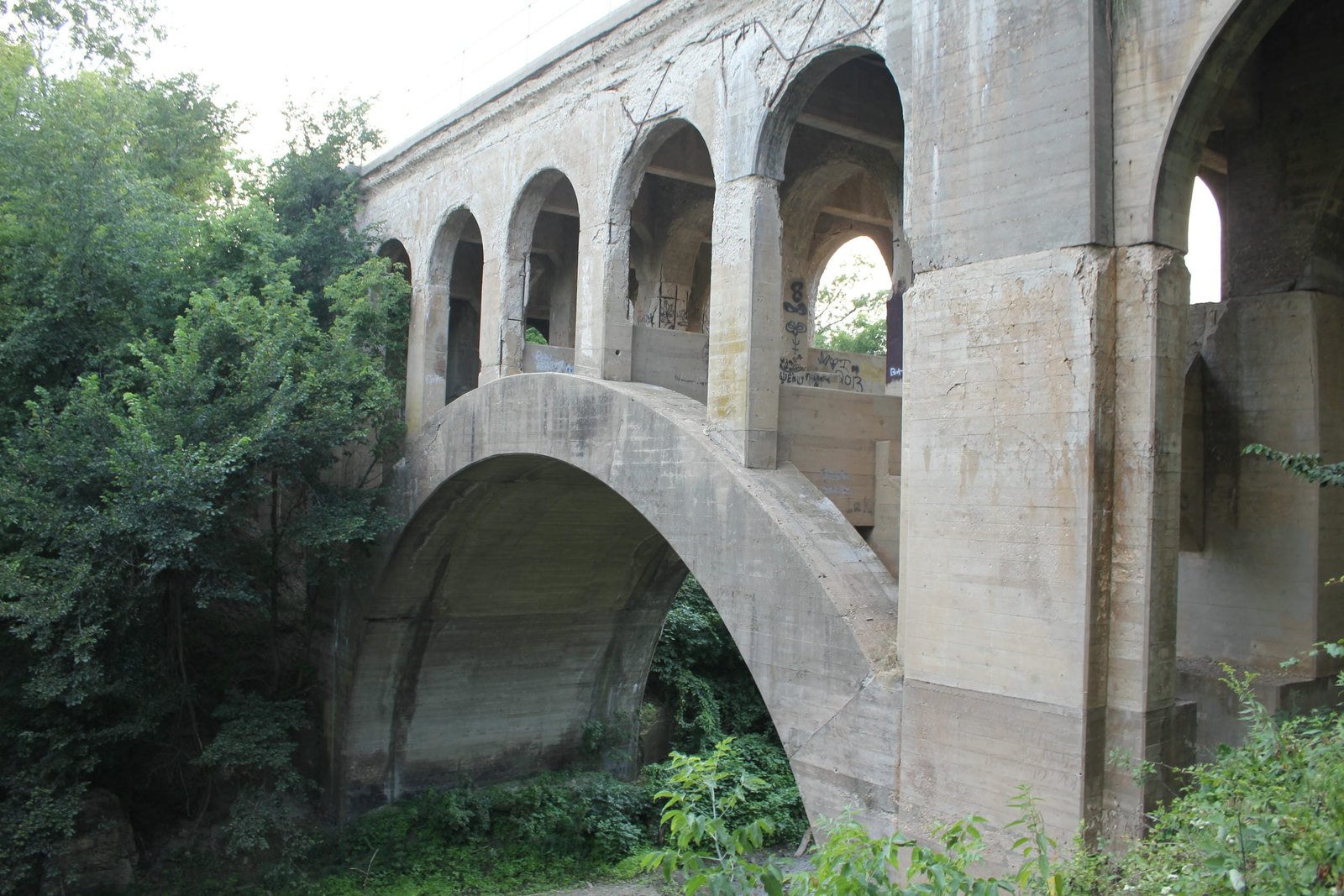

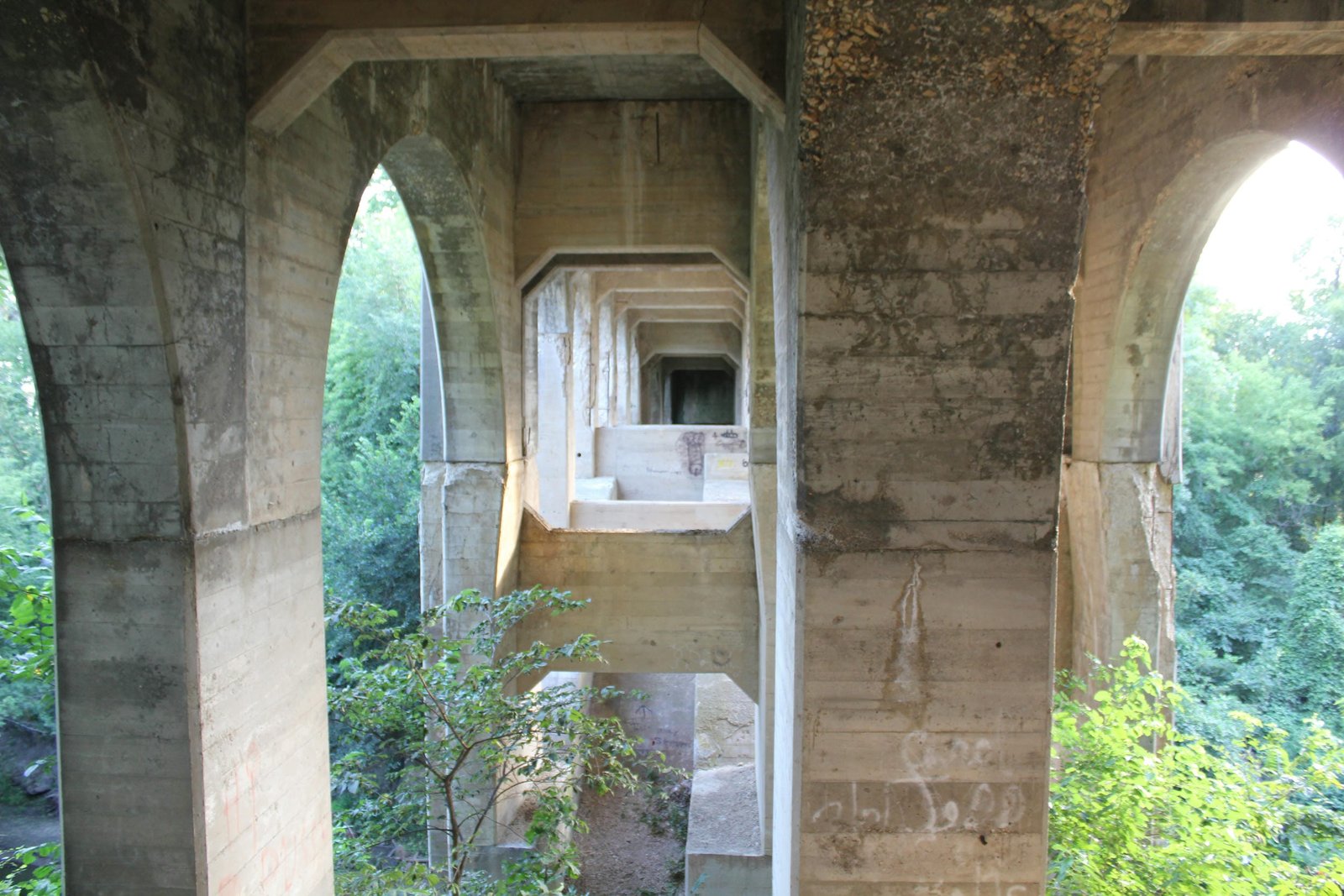

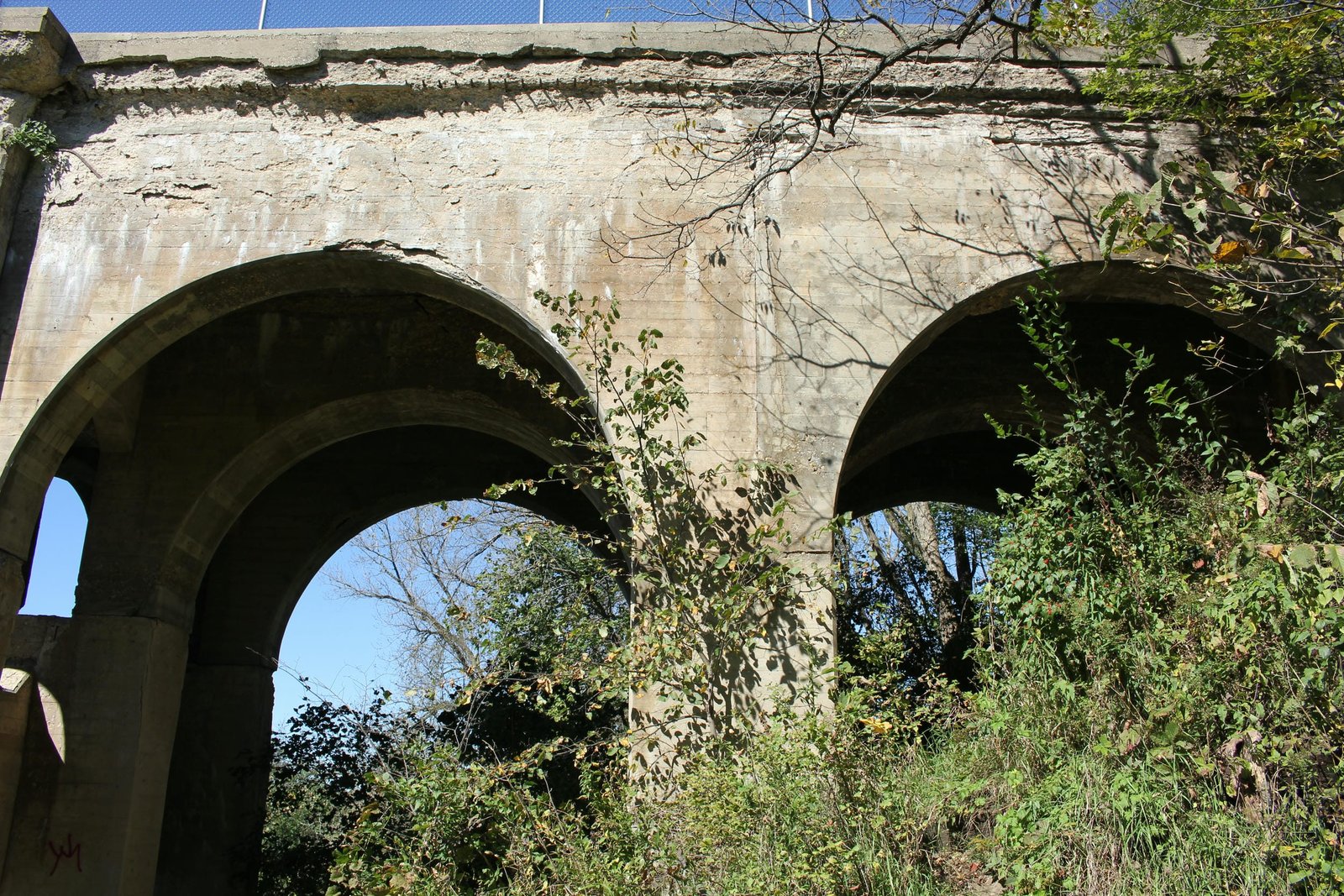

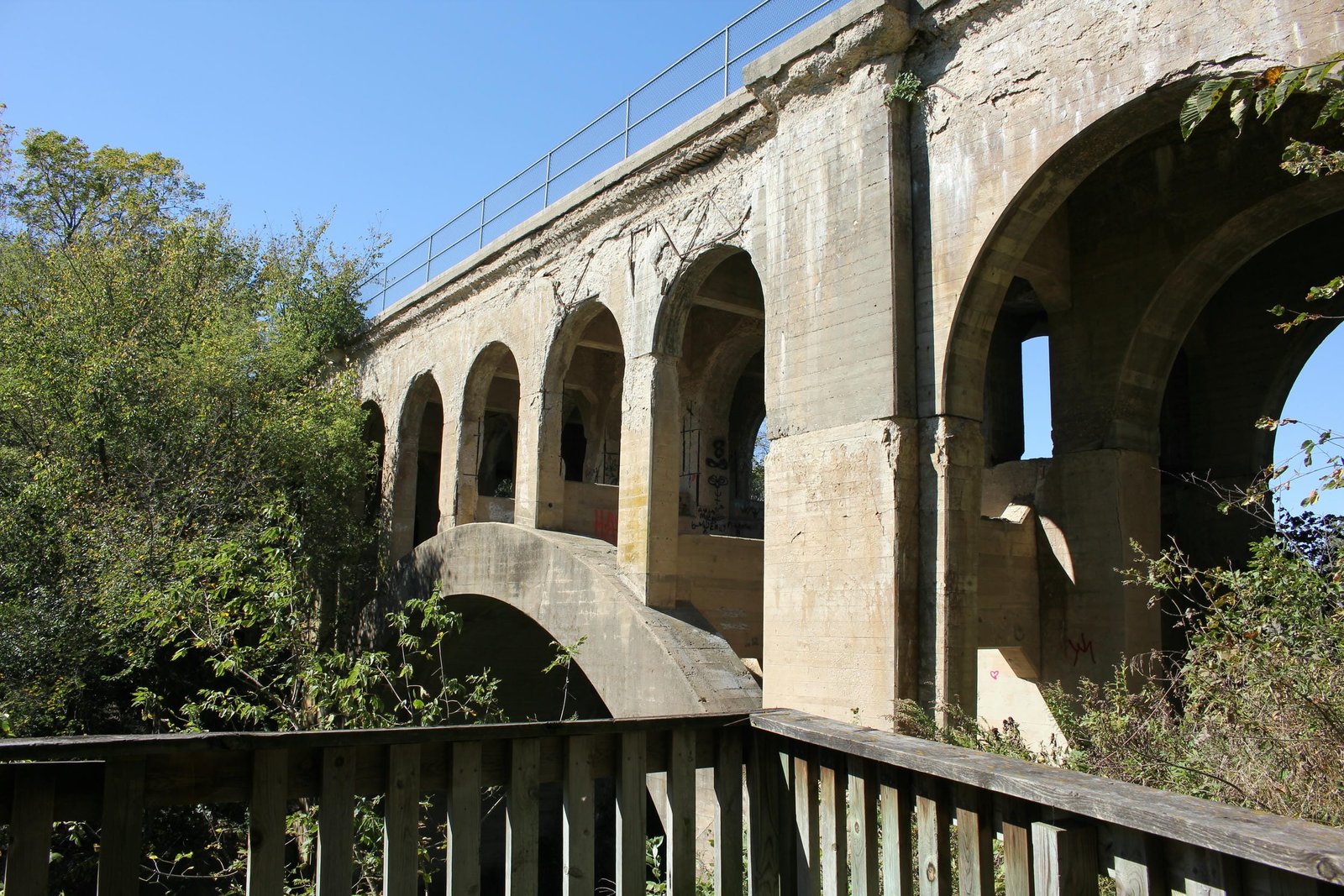

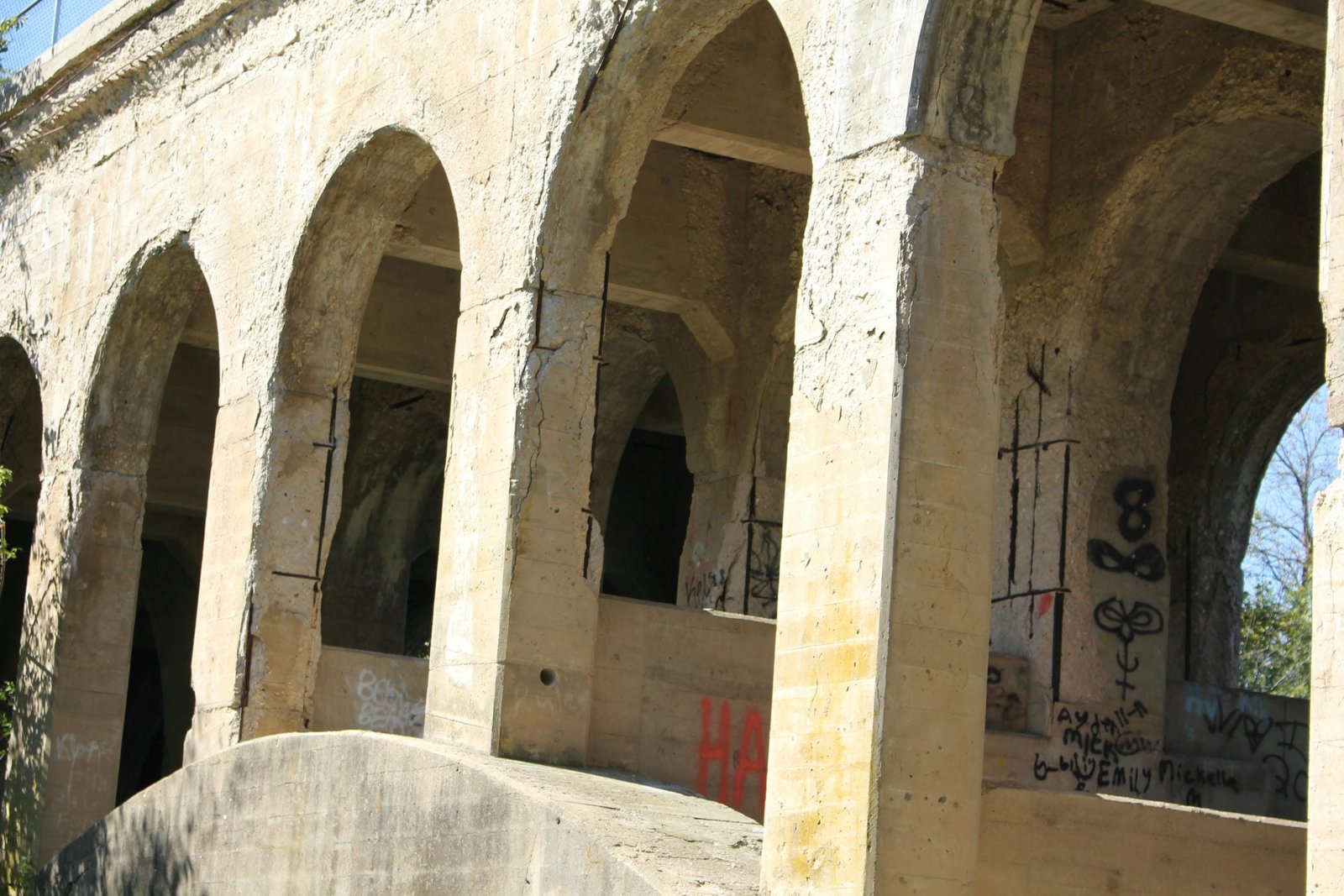

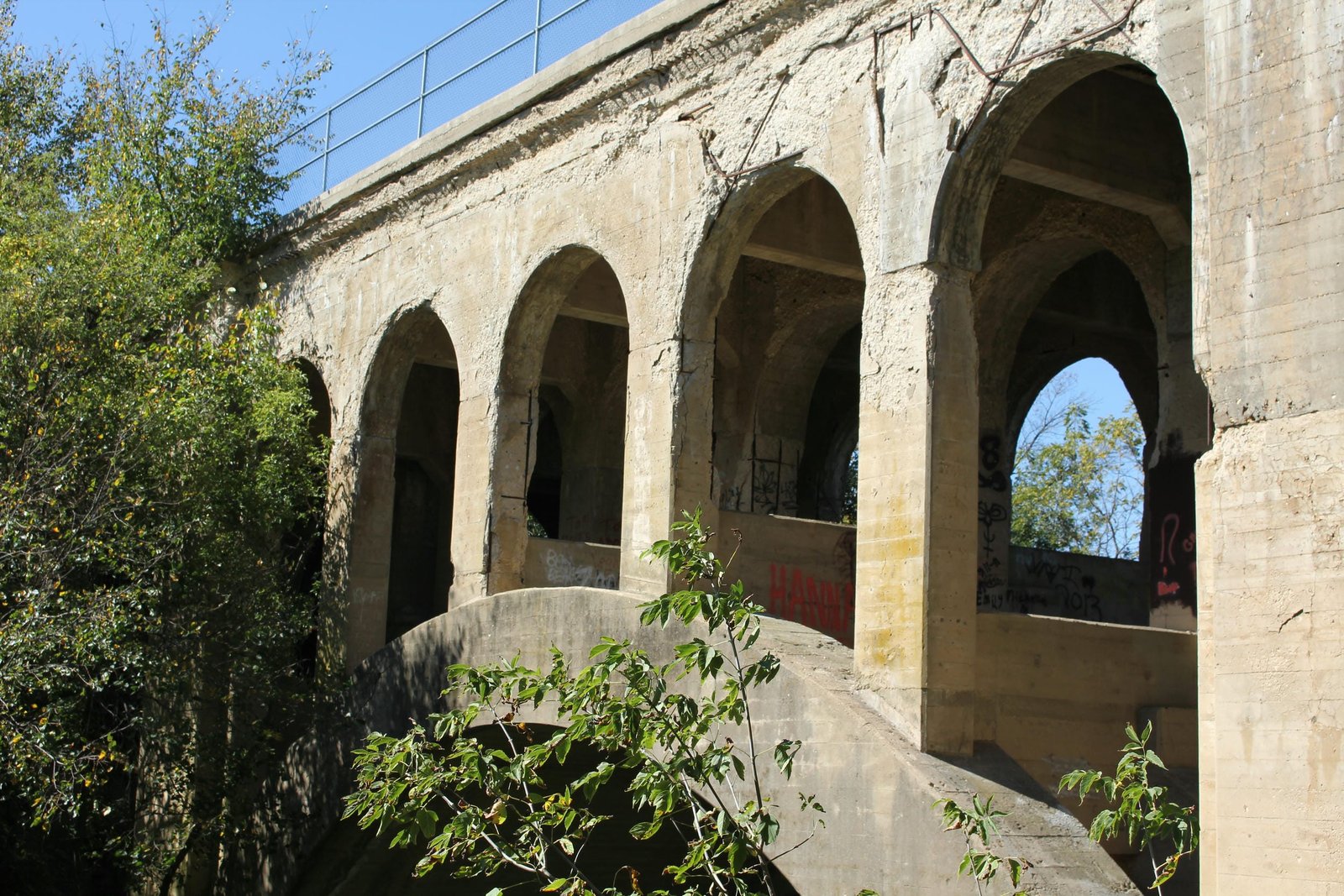

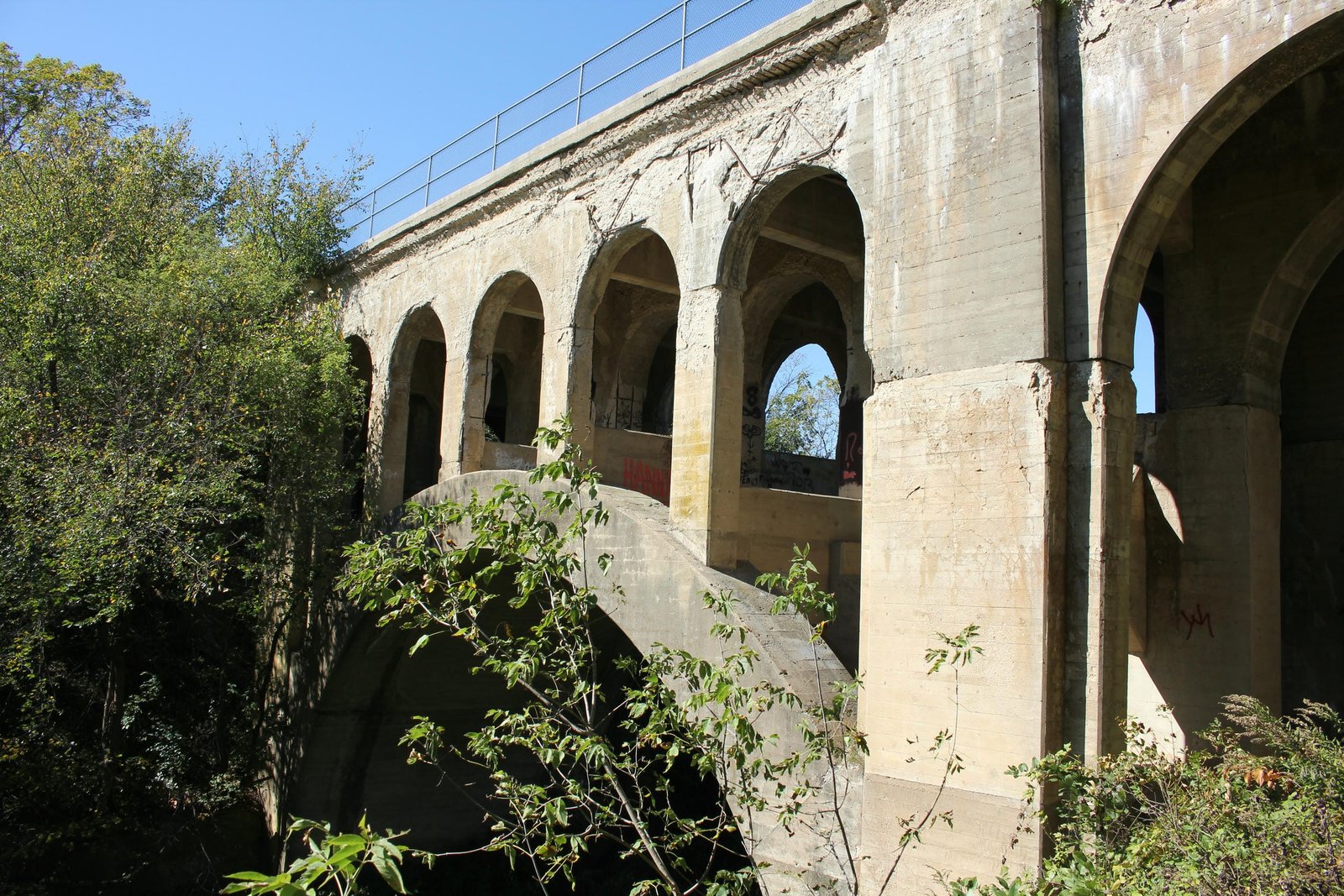

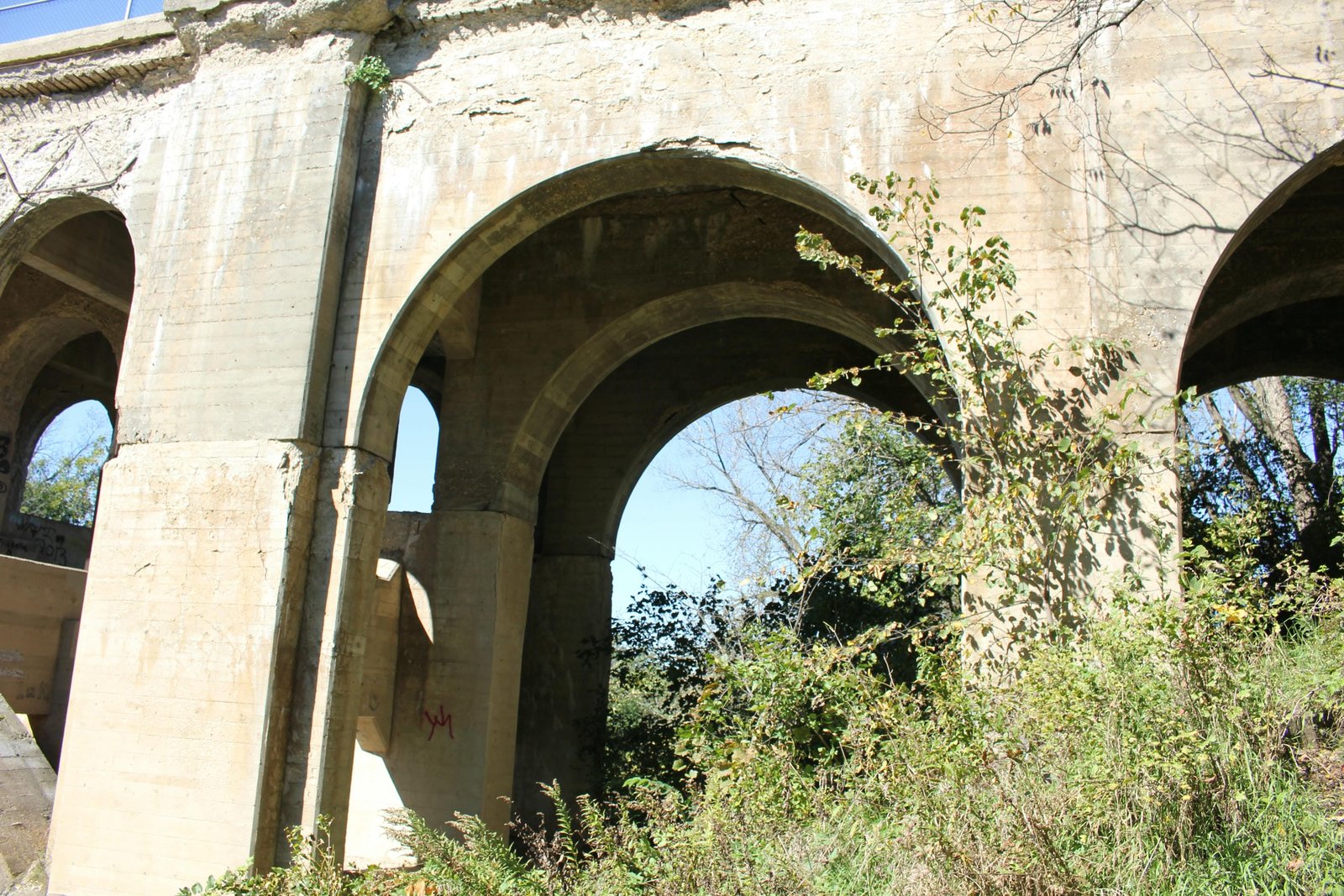

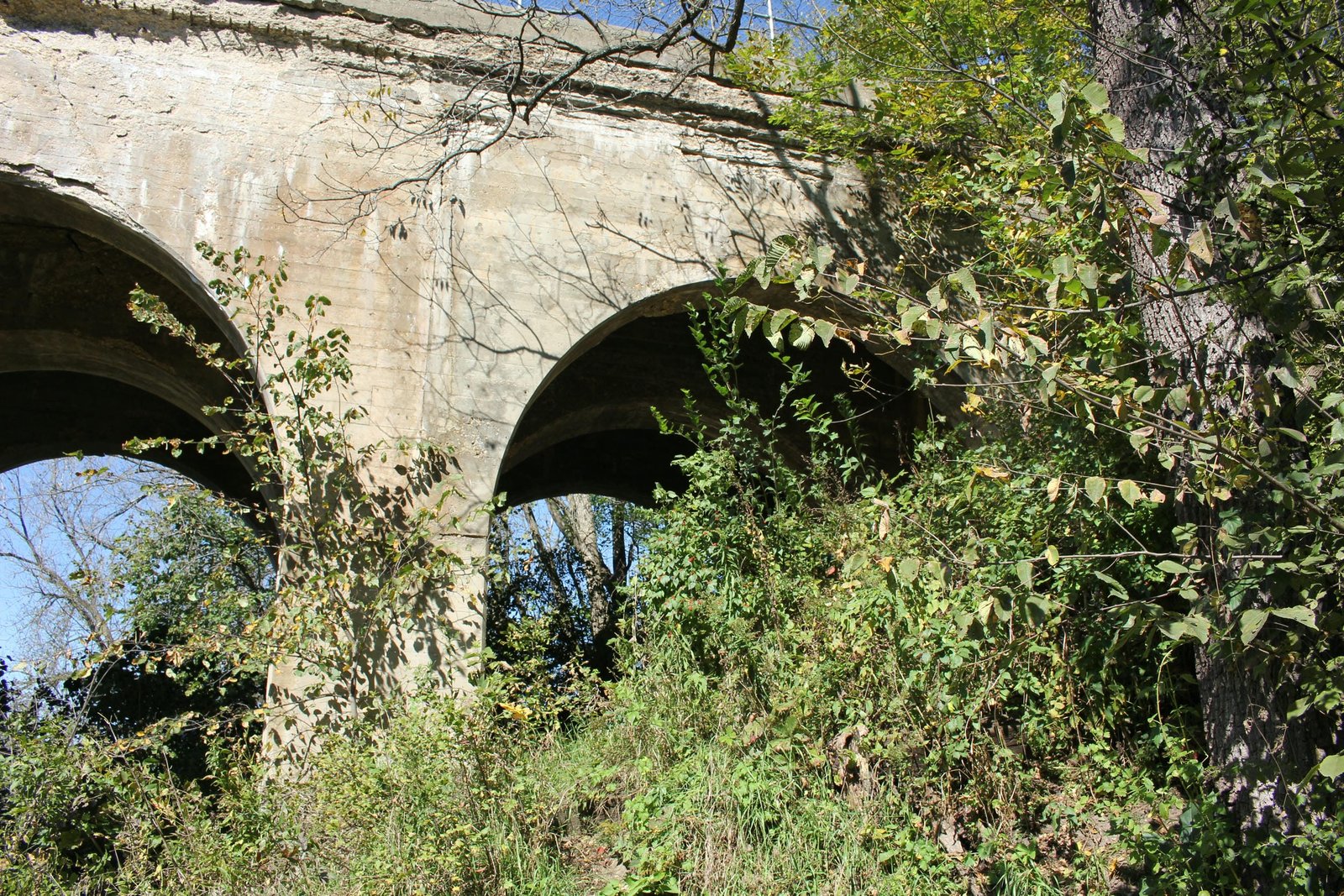

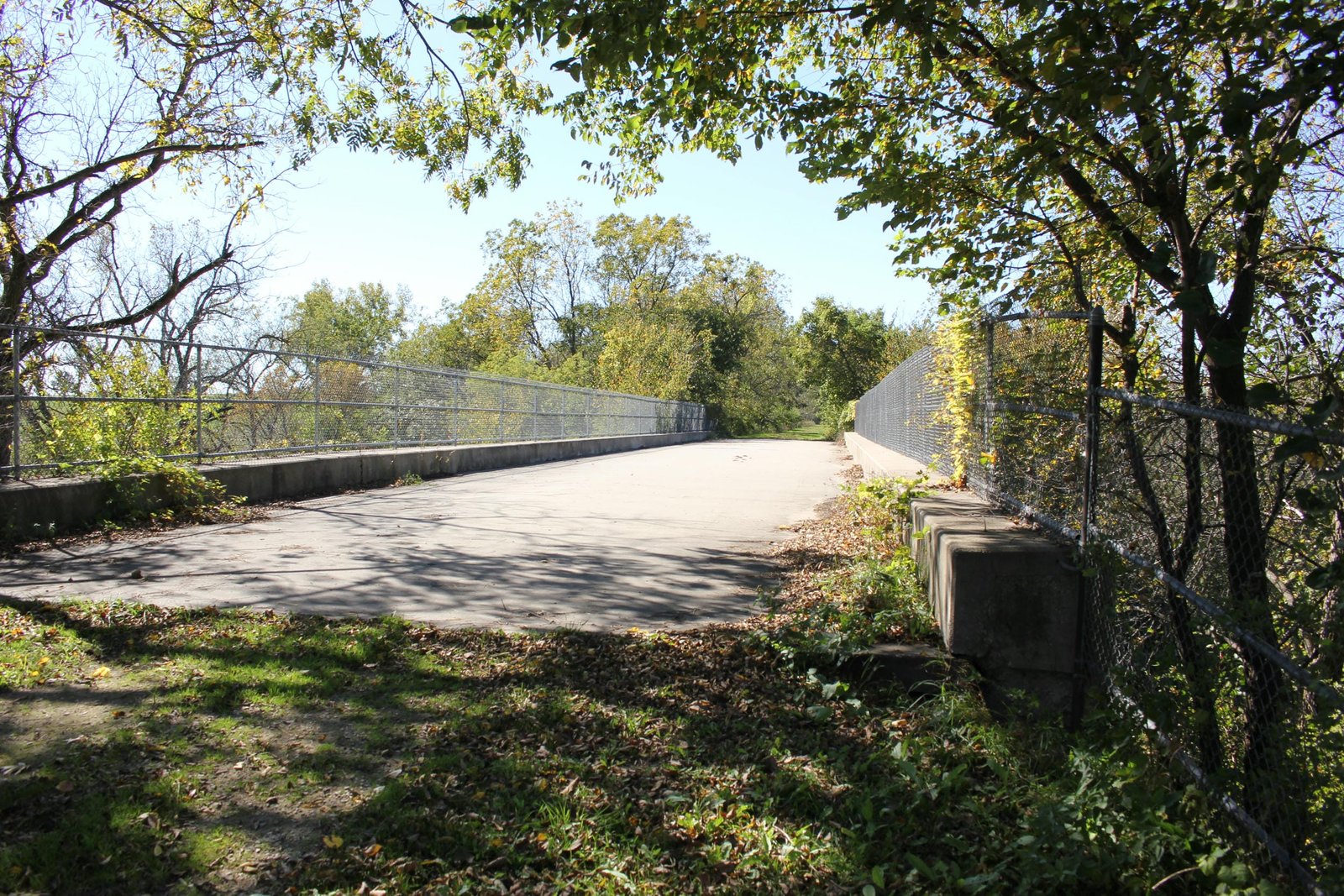

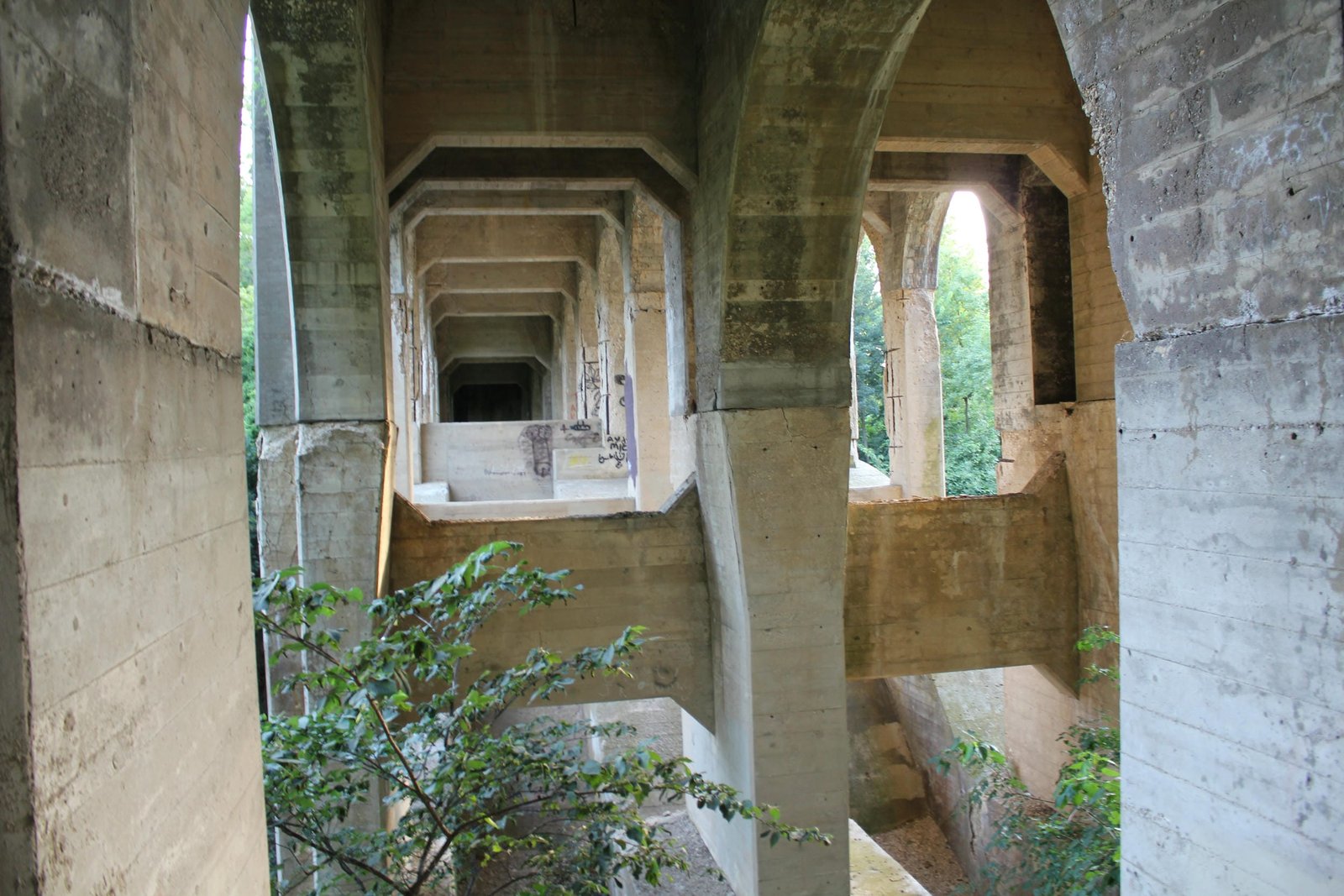

Currently, the bridge consists of a 60-foot open spandrel concrete arch, approached by a pair of 20-foot closed spandrel concrete arch spans on either end. The entire bridge is set onto concrete substructures, which are founded on timber piles. The bridge is constructed at a width of 29 feet, and stands 56 feet above the waterway below. The entire bridge follows an unusual design, which is a hybrid of a concrete arch and a concrete frame design. The center span consists of three main elliptical arch rings at the base, which support three rows of upper spandrel walls, each with five semicircular openings. The three main arch rings are connected by a slab throughout, forming a solid arch ring. In addition, transverse beams are placed at the columns between the five upper openings. At the top of the openings, the span is further reinforced by an additional set of transverse beams, which support the concrete slab deck. The main piers consist of rectangular concrete columns, braced by transverse beams with flared top and bottom edges. Each approach consists of three rows of closed spandrel concrete arches, which are similarly constructed to the upper spandrel wall of the main span. The piers of the approaches consist of three rectangular concrete columns, which are connected by both transverse and longitudinal beams beneath ground level. The abutments are similarly constructed to the approach piers, but also use a triangular cantilevered section to help anchor the bridge. Construction joints are present at the tops of the upper spandrel columns of the main span and at the bottom of the approach arches. Expansion joints are present throughout the structure, and a pipe system conveys drainage from the bridge. The deck consists of a cast-in-place slab system, with a flared coping which forms the upper parapet wall. The main piers also have an accented design, which is likely functional instead of decorative.

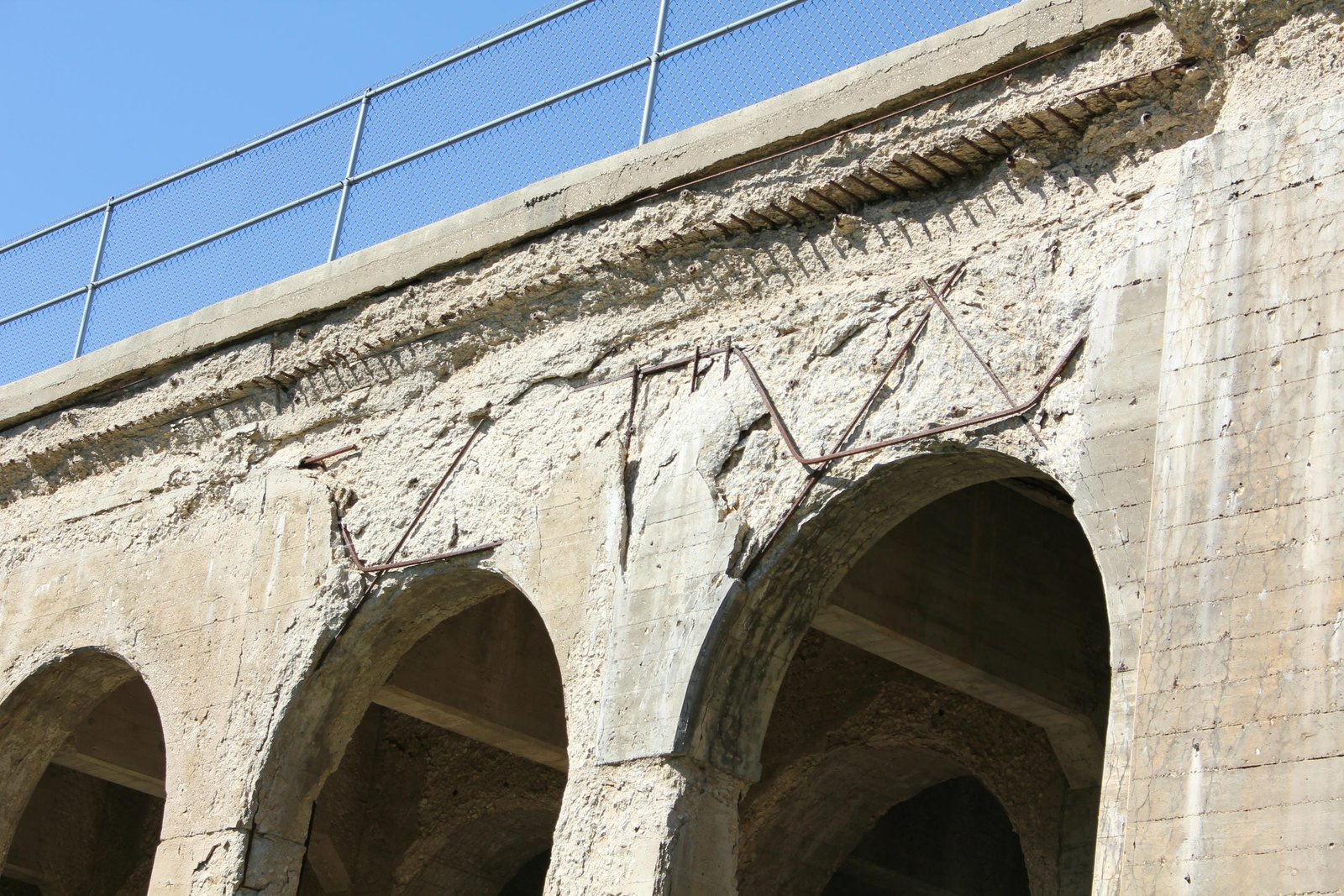

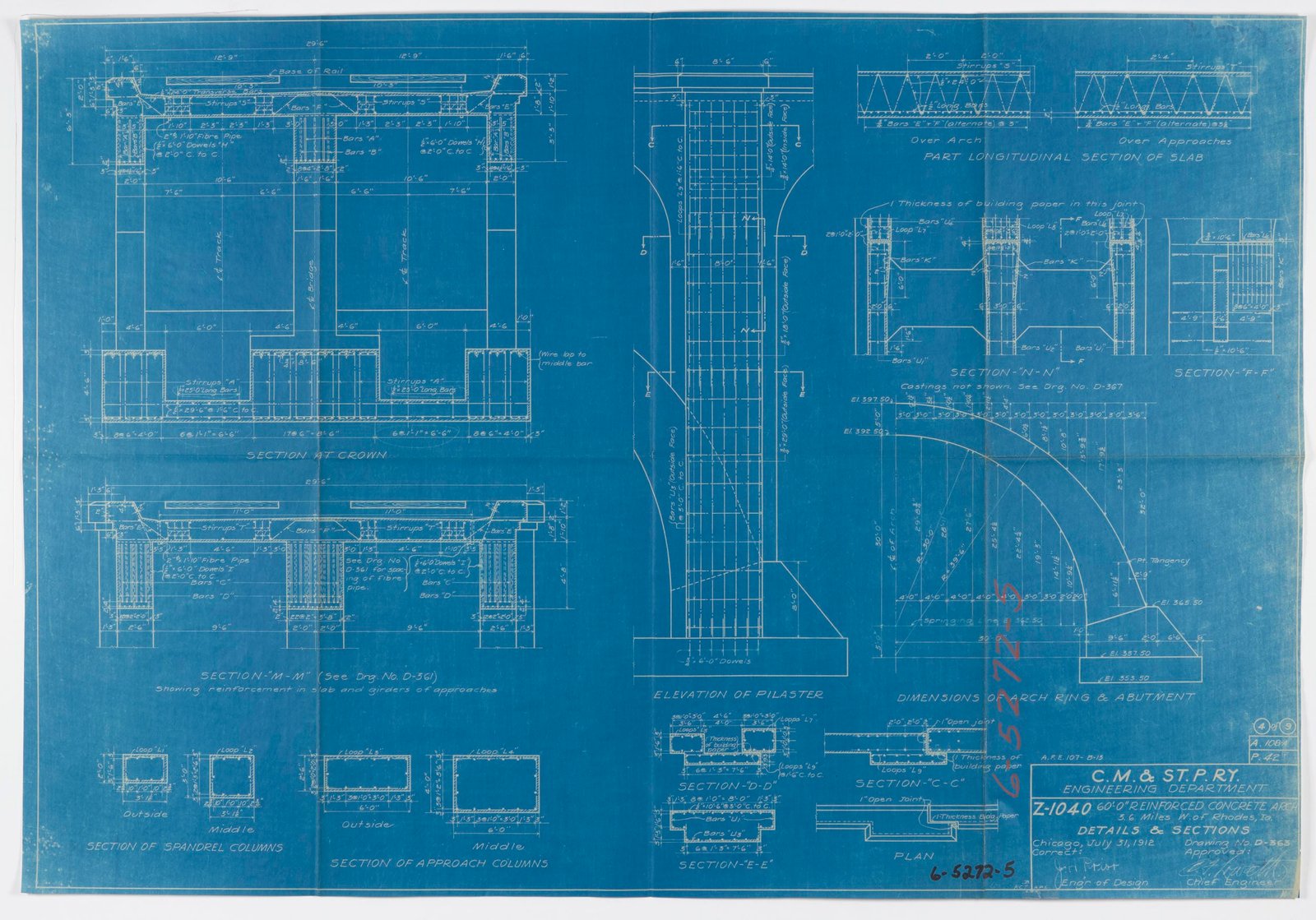

The bridge was designed by J.H. Prior under the direction of Chief Engineer Charles Frederick Loweth. Work was completed under the direction of Concrete Foreman H.E. Dudley; Resident Engineer W.W. Morehouse and Assistant Engineer E.L. Sinclair. A total of 1,730 cubic yards of soil were excavated to construct the bridge, 9,722 linear feet of pile were driven among the 370 piles and a total of 2,894 cubic yards of concrete were used in the construction. It is believed that a mobile concrete plant was used during the construction of the bridge. Typical of Milwaukee Road concrete structures in the early 20th Century, the entire bridge was constructed by labor employed by the Milwaukee Road Bridge & Building Department. The Milwaukee Road found this arrangement to be more cost effective than contracting for masonry bridge and culvert construction. Concrete arches became popular for railroad use in the early 20th Century, as they were durable and easy to construct. The Milwaukee Road constructed a handful of similar size concrete arches, including the famed Rosalia Viaduct (Bridge #EE-90) near Rosalia, Washington. Since the initial construction, the bridge has seen no significant alterations. Today, the bridge is used by the Heart of Iowa Nature Trail, which stretches from Melbourne to Slater. As part of the reuse as a trail, the ballast was removed from the deck, the deck refinished and chain link railings added to the structure. In addition, an observation platform was constructed at the southeast quadrant of the bridge. Overall, the bridge appears to be in fair to poor condition, with several areas of significant spalling and exposed rebar. However, these defects appear to potentially be cosmetic in nature. The bridge appears to be exhibiting minimal cracking, which would indicate structural failure. Even with the noted defects, the bridge should be able to safely carry pedestrian traffic and emergency vehicles for the foreseeable future. The author has ranked this bridge as being highly significant, as it is among the largest concrete railroad bridges in Iowa and an excellent example of Milwaukee Road engineering. The author hopes that this bridge receives a proper rehabilitation in the coming years, which should include spot concrete repairs to the spalled areas. This treatment should be reasonably cost effective, extending the life of this iconic bridge for generations to come.
Citations

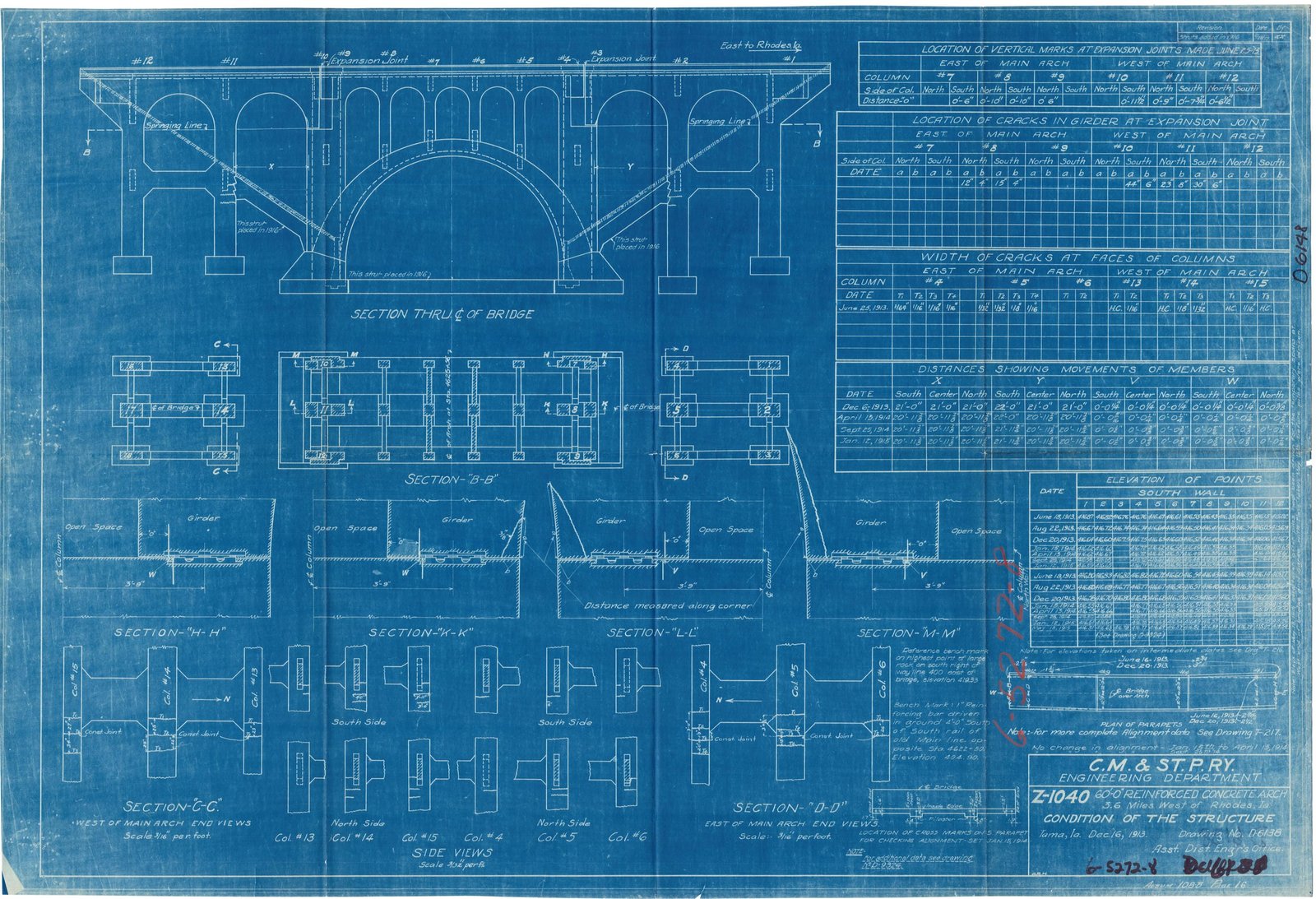

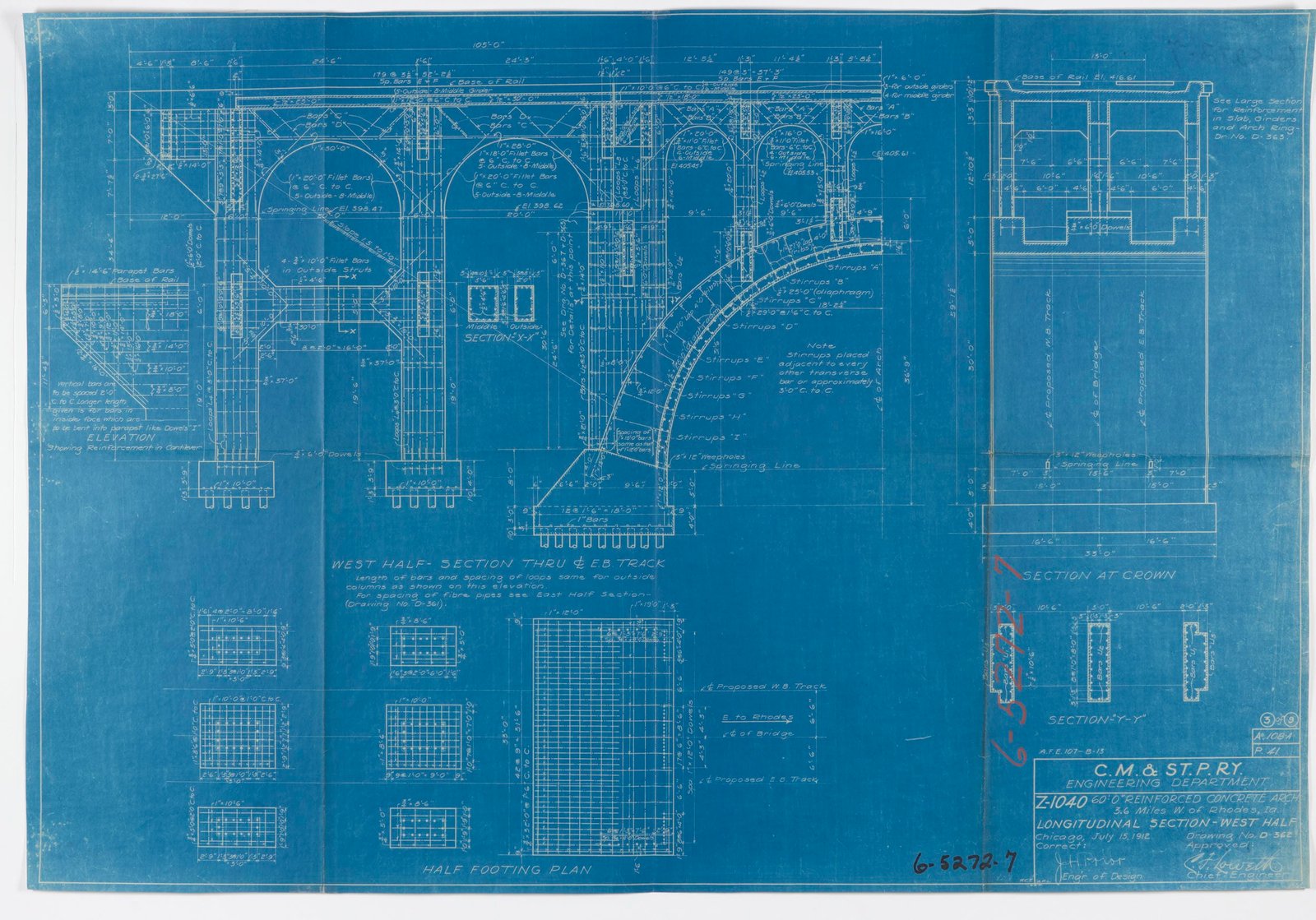

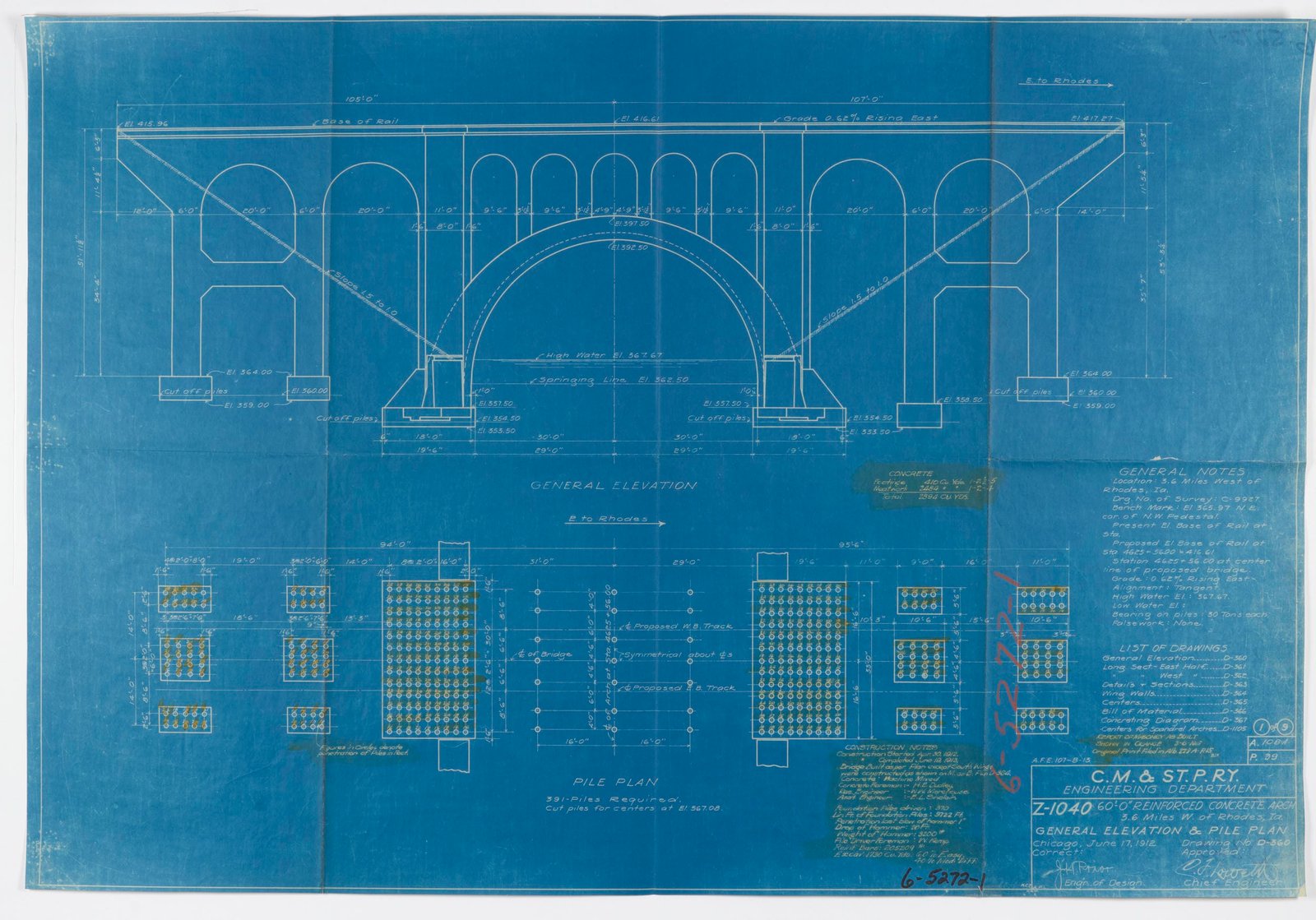

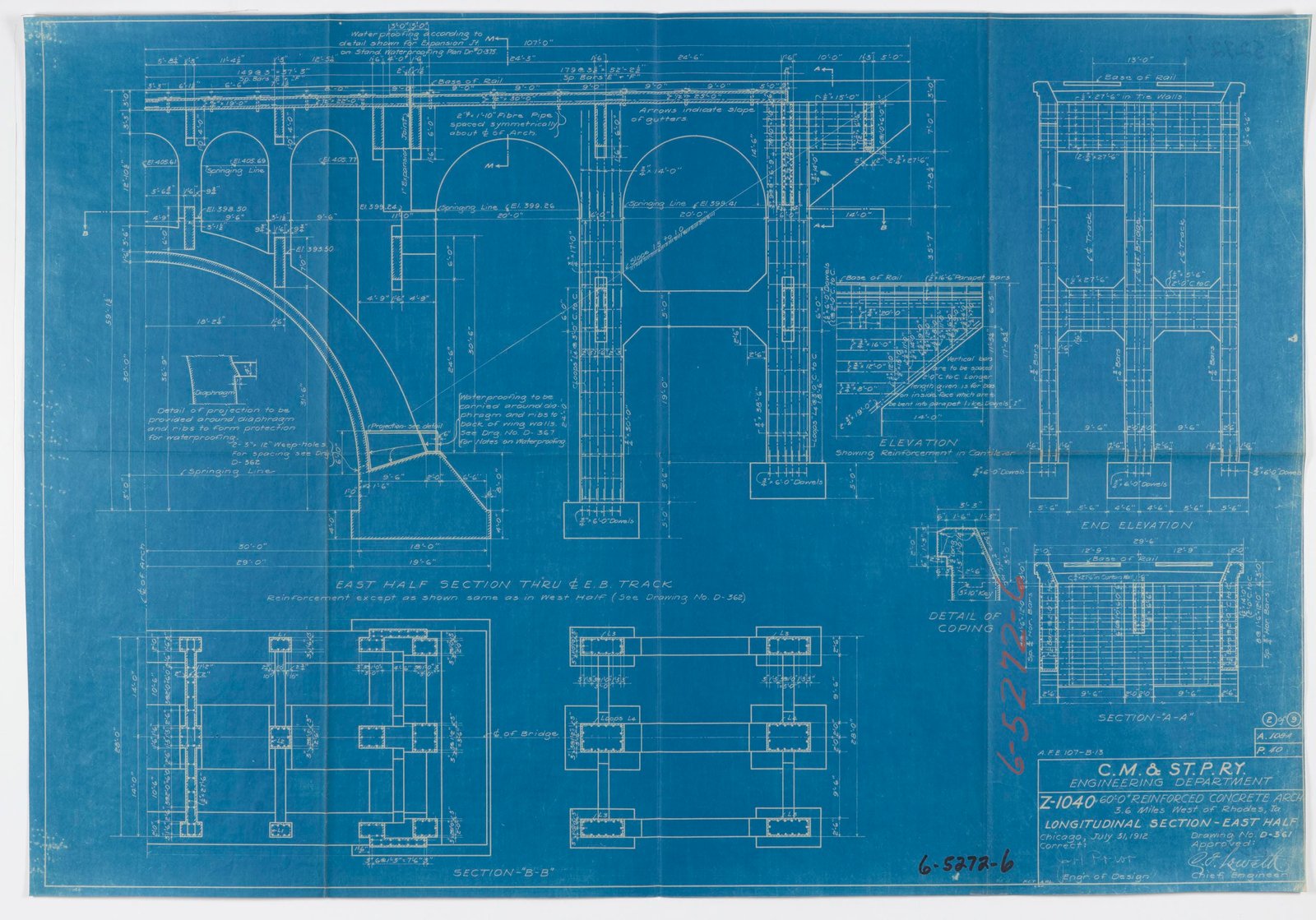

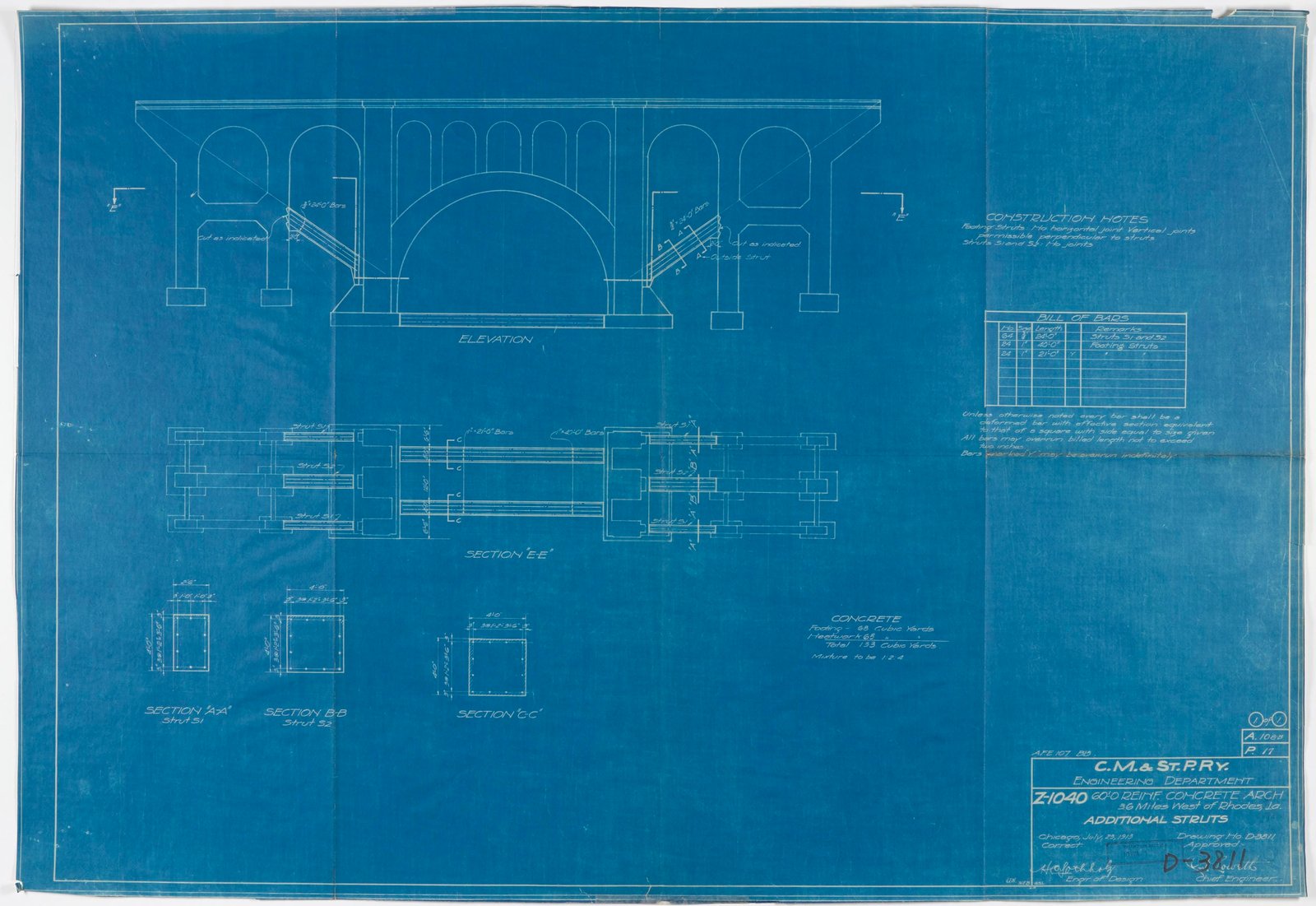

| Build date and engineers | Milwaukee Road Drawing Collection, located at the Milwaukee Road Archives at the Milwaukee Public Library |
| Railroad History Citation | ICC Valuation Information, Compiled by Richard S. Steele |
